model

How to Write a Contractor Design Agreement: What to Include and How to Price It

A design agreement is a paid contract for the planning phase of a remodel. What it includes, how to write each section, how to price the fee, who owns the drawings, and whether the fee is credited later.

Direct answer: A design agreement is a paid contract for the planning phase of a remodel. It names the deliverables, the fee, the timeframe, what is excluded, whether the fee is credited later, and who may use the drawings and specifications. It should end with defined deliverables and a clear next step toward a construction contract, or a clean end to the planning relationship. This guide's practice is no credit, with the drawings remaining the contractor's.

The assumptions

This model assumes

  • A residential remodel that needs planning before it can be priced
  • Whether and when to charge for planning is settled; see When to Charge for the Estimate, and How Much
  • The owner's practice: no credit, and the drawings remain the contractor's
  • Sample language is a drafting example, not legal advice. Have your final form reviewed in your state.
  • The $132.80 rate and the $40,000 average project are published Clamp model figures; the 18 planning hours are an illustration

The model, step by step

1Where a design agreement sits

Four documents get confused, and they do different jobs.

Four documents, four jobs
DocumentWhat it is for
EstimatePrices work you can already describe
Feasibility studyAnswers whether the project can be built, here and for this budget, before design starts
Design agreementPays for the work of defining the project: drawings, specifications and a buildable price
Construction contractAuthorizes and prices the construction itself

A feasibility study comes first when the questions are about the site or the money rather than the design: existing plans that need a budget check, setbacks, variances, code problems, environmental issues, or whether the customer can afford what they want. Michael C. Stone, a builder and remodeler with more than six decades in the industry and the author of Profitable Sales, the book this guide draws on most, treats it as a separate paid stage. Plenty of jobs skip it and go straight to design.

A design agreement is not the construction contract and does not authorize construction. Signing one commits the customer to planning, and nothing more.

2What it includes

Every design agreement needs five things, and most need several more.

What goes in, and how often
ItemInclude
The parties and the project addressAlways
The planning scope, listed specificallyAlways
The fee and payment termsAlways
A timeframeAlways
Scope limits and exclusionsAlways
Plans or drawingsUsually
Written specifications, where construction pricing depends on themUsually
A firm construction priceUsually
A draft construction contractUsually
A preliminary scheduleUsually
Site documentation and existing-condition measurementsDepending on the project
Product and finish selections, and allowancesDepending on the project
Documents needed to apply for a permit, never a promise of approvalDepending on the project
Engineering, surveying, an architect's stamp, variance work, permit and agency fees, testingOnly if listed; otherwise excluded

Stone describes the agreement as one or two pages that identify the parties, the work, the price and the timeframe, and limit the scope. Short is fine. Vague is not.

3How to write it, section by section

The language below is a drafting example, not legal advice. Have a lawyer in your state review your final form.

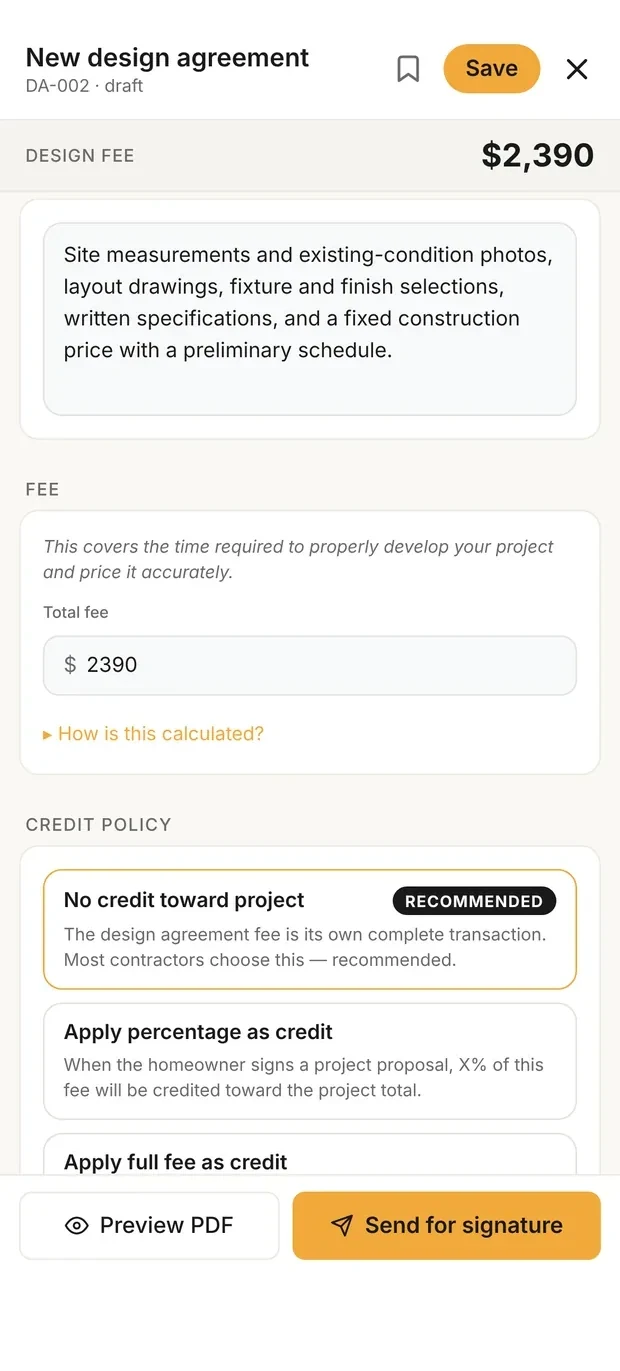

Clamp's new design agreement form showing the deliverable, a $2,390 design fee and the credit policy with No credit toward project selected

Scope, fee, credit

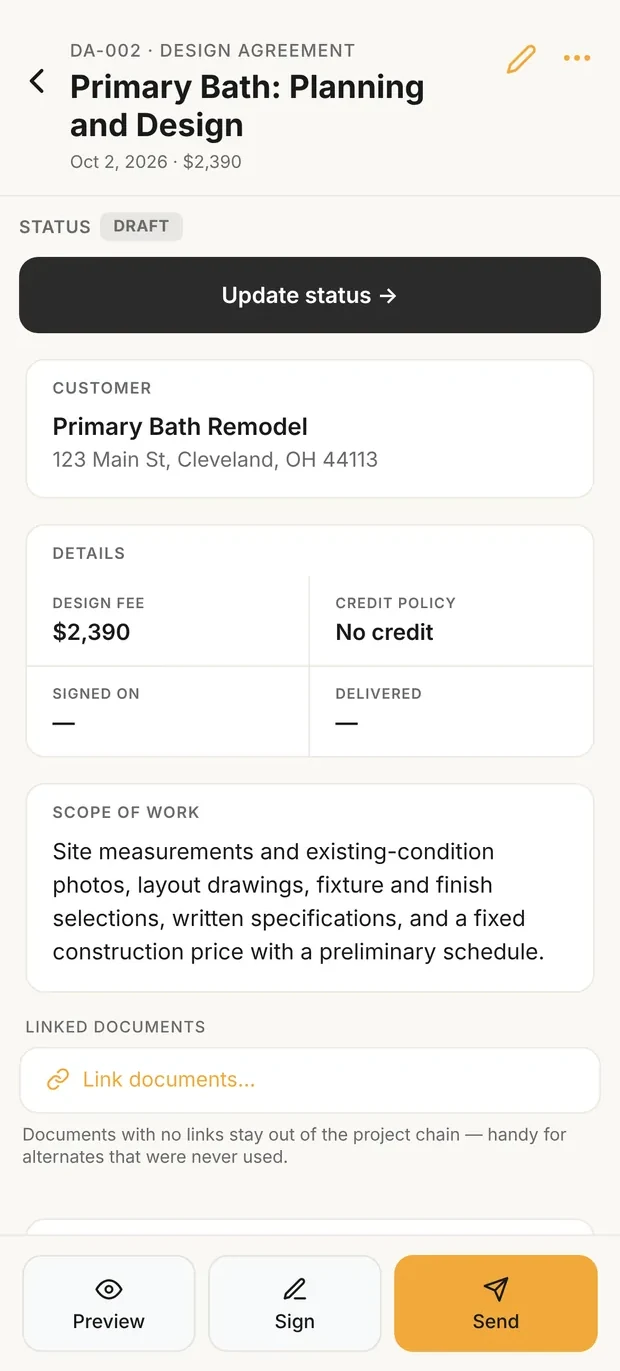

A saved design agreement in Clamp showing a $2,390 design fee, credit policy No credit, and the scope of work

The saved agreement

A design agreement in Clamp: the deliverable, the fee and the credit policy on the form, then the saved agreement. Demo lead; the $2,390 fee is the worked example in step 4.

Parties and projectThis Design Agreement is between [Contractor] and [Customer] for preconstruction and design services for the proposed project at [address]. It does not authorize construction.
DeliverablesContractor will perform only the planning services listed here: [site documentation], [drawings], [selections], [written specifications], [construction scope], [construction pricing], [preliminary schedule].
ExclusionsUnless listed above, this agreement does not include engineering, surveying, services requiring a licensed architect, permit or agency fees, testing, destructive investigation, or construction. If other professional services become necessary, their scope and cost will be agreed in writing first.
Fee and paymentThe fee for the services in this agreement is $____, payable [terms]. Work outside the listed scope requires written approval and an additional fee before it is performed.
CreditThe design fee pays for the planning services described here and is separate from the construction price. It is not credited against a later construction contract.
ScheduleContractor expects to complete the listed services within about ____ of receiving the information, access, selections and decisions required from Customer. Dates may move if outside professionals, agencies, concealed conditions or Customer decisions delay the work.
Meetings and revisionsThe fee includes ____ planning meetings and ____ revision rounds. Additional meetings or revisions will be billed at $____ an hour, under a separate written authorization.
Ownership and useThe plans and specifications prepared under this agreement remain the property of Contractor and may be used only by Contractor to build this project. Contractor is not responsible for their use by anyone else.
CompletionThis agreement ends when the listed deliverables are complete, when the parties sign a construction contract for the project, or on [expiration date]. Fees for work already completed remain due.
SignaturesBy signing, the parties approve the planning scope, fee, schedule, credit terms, exclusions, and ownership and use terms stated here.
4How to price the fee

There are three ways to set the number, and each fits a different product. The paid-estimating guide sets out the ladder from a free fit conversation to a full design package. The design agreement is near the top of it.

Hourly is planning hours times a rate that covers your labor, overhead and profit. Flat is a fixed fee for a defined package, usually built from the hourly estimate. Percentage is a share of the expected construction price: Stone puts a design agreement at 4 to 8% of the total sales price in Profitable Sales. That is his method, not a survey of what contractors charge.

A worked example. The hours are an illustration, not typical hours for any project type.
InputValue
Planning hours (illustration)18
Hourly rate, from the solo contractor hourly model$132.80
Fee$2,390
$2,390 = 18 hours × $132.80

The $132.80 rate comes from that published solo-business model. It is not a recommended design rate for every contractor.

As a cross-check against the percentage method, on the published $40,000 average project from What a Solo Contractor Has to Charge, 4 to 8% is $1,600 to $3,200. The hourly fee lands at 6.0%. That is a sanity check, not a rule. Use your own hours, your own rate and your own average project.

Stone also recommends one practice worth knowing: when subcontractors or suppliers are asked to do design work beyond a normal quote, they should be paid too. If you are being paid for planning, so are they.

5Who owns the drawings

Say it in the agreement, not in a conversation after the customer asks.

The practice this guide uses, following Stone, is that the contractor keeps ownership of the plans and specifications and gives no right for another builder to use them. That is the clause in step 3. It is the cleanest answer to "can I take your drawings to someone else?", because the customer agreed to it before you drew anything.

Copyright, architectural licensing and state law can all affect how ownership and use rights work, so have the final clause reviewed in your state.

6Credit it or keep it

When the customer goes ahead with construction, the fee can either come off the construction price or stand on its own.

Three credit policies
PolicyWhat it says to the customerWhat it does to you
No creditPlanning is a product with its own valuePaid once, whether or not you build
Full creditPlanning is a down payment on the jobThe fee becomes part of the construction price
Partial creditSome of eachThe split is yours to set

Stone shows both approaches. His worked example credits the fee, and he notes that many contractors treat design as a separate service and do not. This guide recommends no credit, because the planning work has real labor and real value of its own. If the construction price is calculated independently and the design fee is then credited without being built into that price, the credit reduces the money available for overhead and profit. What a discount really costs shows how fast that adds up.

Older practice used a different tool: one design fee if you build the job, and 1.75 to 2 times that if the customer takes the plans elsewhere. Stone recommended it to stop contractors being used as low-cost designers. A clear ownership clause, in step 5, addresses the same concern from a different direction: it defines who may use the work product, instead of changing the fee depending on who builds the project.

Whichever you choose, write it down before any work starts.

7After it is signed

The planning deliverables become the basis of the construction proposal. The final scope, specifications, selections and price are carried into the proposal or attached to it as needed.

With no credit, the proposal is priced on its own, at your normal markup, with no planning fee to subtract. If the customer does not go ahead, the planning relationship ends under the agreement's terms: the fee for completed work was earned, and the drawings stay yours.

8Objections, and the usual mistakes

Most objections are answered by something the agreement already says.

What the customer says, and what to say back
The customer saysWhat to say back
"Other contractors estimate for free."A fit or budget conversation is free. Plans, specifications and a buildable price are work, and this agreement pays for it.
"Why pay before I know the price?"The planning phase is what produces a price you can hold. Without enough planning, the number rests on an incomplete scope and carries more uncertainty.
"Just send me a quote."Explain the process: define the project first, then price it, under a paid agreement.
"What if I don't build with you?"The agreement already says: the fee pays for the planning services, and the plans and specifications remain ours, for our use on this project.
"Can I take your drawings to someone else?"Answer from the ownership clause, which they have already signed.
"I already have plans."Offer a feasibility study instead: whether those plans can be built, here, for this budget.
The usual mistakes
MistakeInstead
Vague deliverablesList them specifically
No timeframeState one
Planning, estimating or specifications before being paidSign the agreement first
No ownership and use clausePut it in writing
A credit policy decided after the factDecide before any work starts
Unlimited revisions or meetingsSet a number
Treating a feasibility question as designOffer a feasibility study
Expecting subs and suppliers to design for freePay them for design work
Mixing a design agreement with a letter of intentKeep them separate contracts
No terms for delays when outside design or engineering needs correctingCover them in the schedule clause
Pricing the planning phase without its outside costsInclude engineering, drafting and specialty design in the fee, or authorize them separately

What it means

What this saysA design agreement sells planning as a product: a defined scope, a fee, a timeframe, limits, and a clear rule on who may use the work. Written that way, the customer knows what they are buying before you draw anything, and the fee is earned whether or not they build.
A design agreement is not a deposit on a future job. It is the first thing you sell.

Design agreements in Clamp

A design agreement in Clamp is its own document, separate from the proposal, and your customer signs it in the portal. The scope can be a written description or line items, the fee can be shown as flat, a percentage or hours times a rate, and the credit policy defaults to none.

Settle whether and when to charge first in When to Charge for the Estimate, and How Much, and score your Offers system in the contractor business self-assessment.
