10x10 Kitchen Remodel Cost: Every Line, Itemized (2026 Baseline)

A 100-square-foot L-shaped kitchen gutted and rebuilt on the same layout: stock cabinets, quartz, tile backsplash, LVP and electrical to code, itemized with crew hours.

Direct answer: Gutting and rebuilding a 10x10 L-shaped kitchen on the same layout has a direct job cost of $22,399 for this kitchen in this example. At illustrative markups of 30% to 100%, that is a selling price of about $29,118 to $44,797. Direct job cost is labor and materials only, with no contractor overhead or profit, and is not a price: no contractor performs work at job cost. Permit and inspection fees are not included.

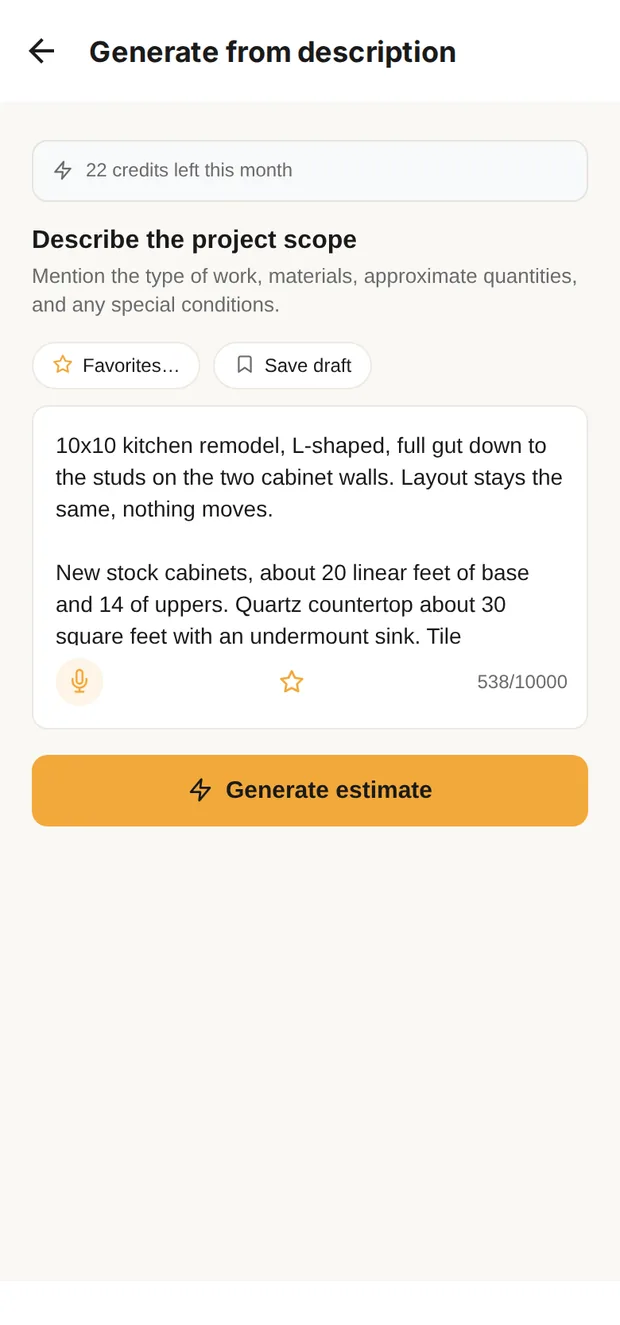

Clamp's Generate from description screen with the 10x10 kitchen remodel described in plain words

Describe it

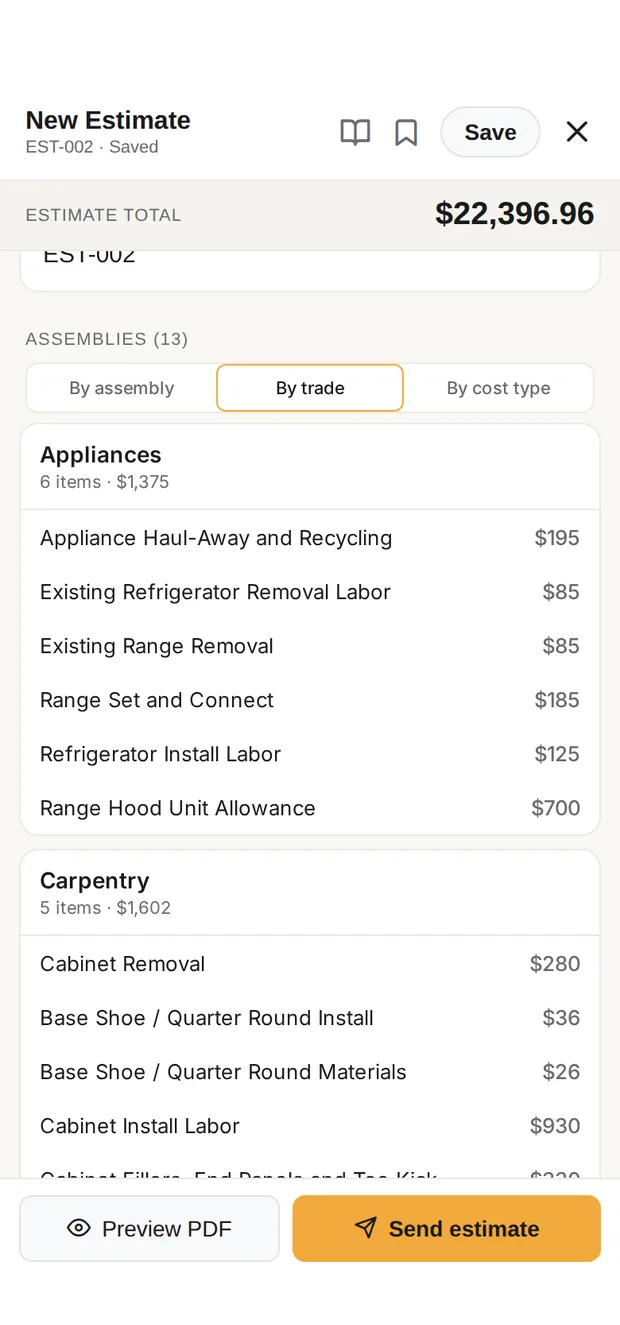

The estimate for the 10x10 kitchen remodel in Clamp's builder: total $22,396.96, grouped into appliances, carpentry, electrical and the other trades

Every line, by trade

The 10x10 kitchen in the Clamp app: described in plain words, then the draft at $22,397 job cost, every line grouped by trade. Sample data.

The job at a glance

One build, fully itemized, with crew hours.

BuildJob costLaborCrew hoursMaterialsIllustrative selling price
A. 10x10 kitchen, same layout$22,399$11,249133 to 161 h$9,170$29,118 to
$44,797

Dump fees and other costs ($1,980) are the same in every build and included in the job cost. Materials include allowances. Illustrative selling price is the job cost at a 30% to 100% markup; your price depends on your own overhead and profit. Labor hours are a planning range and include setup, daily cleanup and material runs; they are never a charge to the customer. Permit and inspection fees are not included; requirements vary by jurisdiction.

The build in detail

A. 10x10 kitchen, same layout: $22,399

The two cabinet walls are gutted to the studs; new circuits, code counter outlets, four recessed lights and a vented hood go in; drywall is hung and painted; 20 linear feet of stock cabinets, a quartz top with an undermount sink, a tile backsplash and an LVP floor follow; the homeowner's appliances are set and connected. Labor is $11,249 of the $22,399 job cost, or 50.2%. It is about 133 to 161 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLow-Overhead×1.30Established×1.50Full-Service×2.00
Permits & PM7 to 13 h$590$767$885$1,180
Demo & Prep4 to 8 h$475$618$713$950
Plumbing8 to 12 h$1,460$1,898$2,190$2,920
Electrical26 to 37 h$3,840$4,992$5,760$7,680
HVAC4 to 8 h$585$761$878$1,170
Drywall14 to 23 h$1,040$1,352$1,560$2,080
Carpentry13 to 24 h$1,246$1,620$1,869$2,492
Tile5 to 9 h$415$539$623$830
Flooring2 to 5 h$225$292$337$450
Painting4 to 7 h$333$433$499$666
Vanity & Fixtures4 to 11 h$560$728$840$1,120
Appliances3 to 5 h$480$624$720$960
Setup, cleanup and material runs9 to 29 hin the prices
All labor133 to 161 h$11,249$14,624$16,874$22,498

Every line item

Labor $11,249 + materials and allowances $9,170 + dump fees and other $1,980 = $22,399 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Permits & PM
Final Cleanup & Walkthrough1ea3 to 9 h$300$0$300
Final Punch Walk Labor1ea2 to 6 h$290$0$290
Permits & PM subtotal7 to 13 h$590
Permits & PM subtotal7 to 13 h$590
Demo & Prep
Demo Consumables and Supplies0.67ls$0$84$84
Haul-Off Per Load1ea$0$0$225
Interior Demolition Labor100sf1 to 4 h$175$0$175
Site Protection, One Room (per job)1ea2 to 5 h$300$0$300
Demo & Prep subtotal4 to 8 h$784
Demo & Prep subtotal4 to 8 h$784
Masonry
Stone Install Consumables1ea$0$135$135
Masonry subtotal$135
Masonry subtotal$135
Plumbing
Countertop Plumbing Coordination Labor1ea1 to 5 h$450$0$450
Dishwasher Hookup Labor1ea1 to 3 h$325$0$325
Existing Dishwasher Removal Labor1eaunder 1 h$125$0$125
Faucet AllowanceLabor on: Fixture Set Labor1ea$0$250$250
Kitchen Sink AllowanceLabor on: Fixture Set Labor1ea$0$425$425
Fixture Set Labor1ea1 to 4 h$325$0$325
Gas Appliance Set and Connect1ea1 to 3 h$235$0$235
Plumbing subtotal8 to 12 h$2,135
Plumbing subtotal8 to 12 h$2,135
Electrical
Electrical Box ExtenderLabor on: Outlet Integration Labor2ea$0$7$7
Branch Circuit Install3ea6 to 14 h$1,275$0$1,275
Dedicated Appliance Circuit1ea2 to 5 h$425$0$425
Dedicated Circuit Breaker AllowanceLabor on: Branch Circuit Install4ea$0$140$140
Electrical Box and Device MaterialsLabor on: Electrical Rough-In Per Device8ea$0$68$68
Electrical Rough ConsumablesLabor on: Electrical Rough-In Per Device9ea$0$59$59
Electrical Rough-In Per Device9ea3 to 8 h$495$0$495
GFCI/AFCI Device Install2ea1 to 2 h$170$0$170
Gfci Unit AllowanceLabor on: GFCI/AFCI Device Install2ea$0$44$44
Light Fixture Install4ea2 to 7 h$500$0$500
Lighting Dimmer AllowanceLabor on: Outlet/Switch Install1ea$0$32$32
Outlet Integration Labor1ea1 to 3 h$260$0$260
Outlet/Switch Install6ea1 to 4 h$390$0$390
Outlet Unit AllowanceLabor on: Outlet/Switch Install6ea$0$48$48
Range Hood Install Labor1ea1 to 5 h$325$0$325
Recessed Can Allowance4ea$0$152$152
Romex Wire MaterialsLabor on: Electrical Rough-In Per Device110.4lf$0$88$88
Electrical subtotal26 to 37 h$4,478
Electrical subtotal26 to 37 h$4,478
HVAC
Appliance Vent Termination1ea1 to 4 h$325$0$325
Range hood exhaust duct install10lf2 to 5 h$260$0$260
Range hood exhaust duct materialsLabor on: Range hood exhaust duct install10lf$0$115$115
HVAC subtotal4 to 8 h$700
HVAC subtotal4 to 8 h$700
Drywall
Drywall Removal320sf2 to 5 h$320$0$320
Drywall Finish Labor320sf6 to 13 h$480$0$480
Drywall Hang Labor320sf3 to 7 h$240$0$240
Drywall Sheets MaterialsLabor on: Drywall Hang Labor352sf$0$264$264
Drywall subtotal14 to 23 h$1,304
Drywall subtotal14 to 23 h$1,304
Carpentry
Cabinet Fillers, End Panels and Toe KickLabor on: Cabinet Install Labor12lf$0$330$330
Cabinet Install Labor20lf7 to 17 h$930$0$930
Cabinet Removal20lf3 to 9 h$280$0$280
Base Shoe / Quarter Round Install19lfunder 1 h$36$0$36
Base Shoe / Quarter Round MaterialsLabor on: Base Shoe / Quarter Round Install20.9lf$0$26$26
Carpentry subtotal13 to 24 h$1,602
Carpentry subtotal13 to 24 h$1,602
Tile
Backsplash Removal Labor25sf2 to 5 h$150$0$150
Tile Grout Sealer25sfunder 1 h$15$0$15
Tile Material AllowanceLabor on: Wall Tile Install25sf$0$137$137
Tile Setting MaterialsLabor on: Wall Tile Install25sf$0$46$46
Wall Tile Install25sf2 to 5 h$250$0$250
Tile subtotal5 to 9 h$598
Tile subtotal5 to 9 h$598
Flooring
Floor Transition Install2ea1 to 3 h$90$0$90
Floor Transition MaterialsLabor on: Floor Transition Install2ea$0$70$70
Floor Underlayment Materials60sf$0$33$33
Flooring Install Consumables1ea$0$85$85
LVP/LVT Install60sf1 to 4 h$135$0$135
LVP/LVT Material AllowanceLabor on: LVP/LVT Install66sf$0$231$231
Flooring subtotal2 to 5 h$644
Flooring subtotal2 to 5 h$644
Painting
Interior Ceiling Paint Apply Labor100sf1 to 2 h$96$0$96
Interior Paint Apply Labor180sf1 to 4 h$130$0$130
Paint Hardware Removal Labor4eaunder 1 h$30$0$30
Paint Masking Setup Labor180sfunder 1 h$7$0$7
Premium Paint AllowanceLabor on: Interior Paint Apply Labor1.76gallon$0$84$84
Paint Prep Labor280sf1 to 2 h$62$0$62
Paint Primer Application Labor27sfunder 1 h$8$0$8
Paint and Primer MaterialsLabor on: Paint Primer Application Labor0.08gallon$0$3$3
Paint Sundries Materials0.45ls$0$68$68
Painting subtotal4 to 7 h$488
Painting subtotal4 to 7 h$488
Vanity & Fixtures
Cabinet Hardware (per piece)32ea$0$96$96
Cabinet Install Fasteners and ShimsLabor on: Cabinet Install Labor20lf$0$55$55
Cabinet Material AllowanceLabor on: Cabinet Install Labor20lf$0$3,600$3,600
Existing Countertop Removal Labor20lf4 to 11 h$560$0$560
Fixture Set MaterialsLabor on: Fixture Set Labor1ea$0$45$45
Stone Countertop Fabrication30sf$0$0$900
Stone Countertop Install30sf$0$0$660
Stone Countertop Material Allowance30sf$0$1,650$1,650
Vanity & Fixtures subtotal4 to 11 h$7,566
Vanity & Fixtures subtotal4 to 11 h$7,566
Appliances
Appliance Haul-Away and Recycling3ea$0$0$195
Existing Range Removal1ea1 to 2 h$85$0$85
Existing Refrigerator Removal Labor1eaunder 1 h$85$0$85
Range Hood Unit AllowanceLabor on: Range Hood Install Labor1ea$0$700$700
Range Set and Connect1ea1 to 2 h$185$0$185
Refrigerator Install Labor1ea1 to 2 h$125$0$125
Appliances subtotal3 to 5 h$1,375
Appliances subtotal3 to 5 h$1,375
DIRECT JOB COST133 to 161 h$22,399
DIRECT JOB COST133 to 161 h$22,399

Methodology & reproducibility

One reviewed snapshot for this build. The build is frozen from its own estimate run and priced by the published pricer.

Direct cost equals the sum of each row’s rounded quantity × (labor + material + other). Amounts are shown in whole dollars; every column adds to its total.

Scope selection, prose accuracy, arithmetic and provenance mapping reviewed; not independent market-rate verification.

Questions

Where does the money go?

Cabinets and the quartz top are the largest single items, but electrical is close behind: three new branch circuits, a dedicated appliance circuit and code counter outlets add up fast in a gut remodel. Labor is about half the job.

Why are appliances not in the total?

The homeowner is buying the range, refrigerator and dishwasher. The estimate carries only the labor to set and connect them, plus a range hood allowance because the hood is vented outside as part of the work.

Is the markup on top of this?

Yes. Direct job cost is what the remodel costs a contractor to perform. The markup table shows what it sells for at illustrative markups of 30% to 100%.
