Project cost · modeled example

Basement Egress Window Cost: Concrete Cut to Finished Well (2026 Baseline)

One code-size egress window cut into a poured concrete wall, with the well, ladder, cover, drainage and interior return, itemized with crew hours.

Direct answer: Adding a code-compliant egress window to a poured concrete basement wall has a direct job cost of $6,840 for this single window with its well and cover in this example. At illustrative markups of 30% to 100%, that is a selling price of about $8,891 to $13,679. Direct job cost is labor and materials only, with no contractor overhead or profit, and is not a price: no contractor performs work at job cost. Permit and inspection fees are not included.

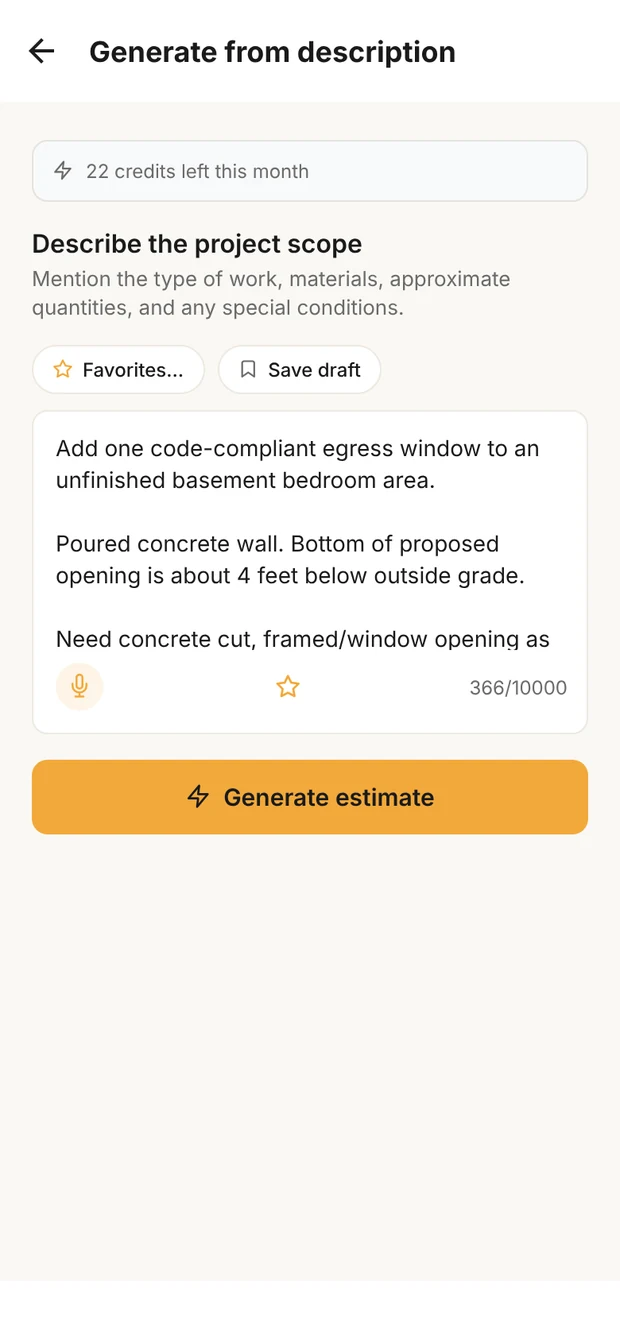

Clamp's Generate from description screen with the egress window described in plain words

Describe it

The egress window estimate in Clamp's builder: total $6,839.60, grouped by trade

Every line, by trade

The egress window in the Clamp app: described in plain words, then the draft at $6,839.60 job cost, every line grouped by trade. Sample data.

The job at a glance

One build, fully itemized, with crew hours.

BuildJob costLaborCrew hoursMaterialsIllustrative selling price
A. Egress window in a poured wall$6,840$3,32434 to 46 h$2,216$8,891 to
$13,679

Dump fees and other costs ($1,300) are the same in every build and included in the job cost. Materials include allowances. Illustrative selling price is the job cost at a 30% to 100% markup; your price depends on your own overhead and profit. Labor hours are a planning range and include setup, daily cleanup and material runs; they are never a charge to the customer. Permit and inspection fees are not included; requirements vary by jurisdiction.

The build in detail

A. Egress window in a poured wall: $6,840

About four cubic yards of excavation, a saw-cut opening in the poured wall, a code-size window, a well with ladder and cover, gravel tied to drainage, and an insulated, trimmed interior return. Labor is $3,324 of the $6,840 job cost, or 48.6%. It is about 34 to 46 hours of work, including setup, daily cleanup and material runs.

Labor cost by trade

Labor only. Materials, allowances and dump fees are in the line items below. Hours are person-hours at typical production from Clamp’s labor hours catalog, as a range: a planning figure, not a schedule and not a charge to the customer.

TradeHoursLabor costLow-Overhead×1.30Established×1.50Full-Service×2.00
Demo & Prep2 to 5 h$300$390$450$600
Sitework1 to 2 h$104$135$156$208
Plumbing1 to 5 h$425$553$638$850
Carpentry21 to 33 h$2,495$3,243$3,742$4,990
Setup, cleanup and material runs2 to 8 hin the prices
All labor34 to 46 h$3,324$4,321$4,986$6,648

Every line item

Labor $3,324 + materials and allowances $2,216 + dump fees and other $1,300 = $6,840 direct job cost. Hours are person-hours at typical production, on labor rows only, and the direct-cost row adds about 15% for setup, daily cleanup and material runs; an allowance or material row names the labor line that installs it, and a subcontract row has none, because the sub’s price includes their own time. Some labor quantities include a difficulty factor, so they can exceed the measured area; each row’s derivation is in the downloadable data.

ItemQtyUnitHoursLaborMaterialLine cost
Demo & Prep
Haul-Off Per Load1ea$0$0$225
Site Protection, One Room (per job)1ea2 to 5 h$300$0$300
Demo & Prep subtotal2 to 5 h$525
Demo & Prep subtotal2 to 5 h$525
Sitework
Concrete Wall Saw Rental1day$0$0$525
Excavation Equipment Rental1day$0$0$550
Excavation Labor4cubic_yard1 to 2 h$104$0$104
Sitework subtotal1 to 2 h$1,179
Sitework subtotal1 to 2 h$1,179
Plumbing
Window Well Drain Tie-In (per well)1ea1 to 5 h$425$0$425
Window Well Drain Gravel (per well)Labor on: Window Well Drain Tie-In (per well)1ea$0$120$120
Plumbing subtotal1 to 5 h$545
Plumbing subtotal1 to 5 h$545
Drywall
Drywall Sheets MaterialsLabor on: Egress Window Interior Return (per window)16sf$0$12$12
Drywall subtotal$12
Drywall subtotal$12
Carpentry
Egress Window Interior Return (per window)1ea3 to 7 h$245$0$245
Egress Window Opening Cut (per opening)1ea6 to 14 h$1,100$0$1,100
Egress Window Install (per window)1ea5 to 11 h$650$0$650
Egress Window Unit (per window)Labor on: Egress Window Install (per window)1ea$0$850$850
Trim MaterialsLabor on: Egress Window Interior Return (per window)16lf$0$34$34
Window Well Cover (per well)Labor on: Window Well Install (per well)1ea$0$350$350
Window Well Install (per well)1ea2 to 6 h$500$0$500
Window Well (per well)Labor on: Window Well Install (per well)1ea$0$850$850
Carpentry subtotal21 to 33 h$4,579
Carpentry subtotal21 to 33 h$4,579
DIRECT JOB COST34 to 46 h$6,840
DIRECT JOB COST34 to 46 h$6,840

Methodology & reproducibility

One reviewed snapshot for this build. The build is frozen from its own estimate run and priced by the published pricer.

Direct cost equals the sum of each row’s rounded quantity × (labor + material + other). Amounts are shown in whole dollars; every column adds to its total.

Scope selection, prose accuracy, arithmetic and provenance mapping reviewed; not independent market-rate verification.

Questions

What makes an egress window expensive?

The concrete: saw-cutting a poured wall, the equipment to do it, and four cubic yards of excavation are $3,324 of labor plus rental days before the window itself. The window, well, ladder and cover are the rest.

Does this make the basement room a legal bedroom?

It provides the code egress opening. A legal bedroom also has ceiling-height, smoke-alarm and other requirements that are finish work, which this build excludes.

What can change the price?

Block walls cut differently than poured; a deeper opening means more excavation and a taller well; and drainage that cannot take the well drain needs its own solution, priced when found.
