model

How to Track What a Job Costs Before You Pay It: Purchase Orders, Bills and Vendors

A purchase order is what you committed to, a bill is what you owe, and a payment is what you paid. Only one of them is job cost. What each record includes, a published countertop sub worked from quote to partial payment, and how to count every purchase once.

Direct answer: A purchase order records what you committed to buy. A vendor bill records what you owe, and its recognized job allocation becomes actual job cost when the goods or work it represents have been received or performed. A payment records that you paid some or all of what you owe. Don't count all three as cost. The job should carry each purchase once, with the purchase order, the bill or receipt, and the payment linked, so you can see what is committed, what it actually cost, what is owed and what is paid without counting a dollar twice.

The assumptions

This model assumes

  • A residential remodeler buying from suppliers and paying trade subcontractors
  • The countertop lines are from the published 5x8 bathroom, version 3; the dates, the payment and the retainage amount are an illustration
  • Retainage is optional and set in the subcontract; state law can govern it
  • Recordkeeping guidance, not tax or legal advice

The model, step by step

1Where it sits

Five records touch one purchase. Only some of them are job cost.

The records around one purchase
RecordWhat it isIs it job cost?
VendorWho you buy from: a supplier or a subcontractorNo
Purchase orderWhat you committed to buy, before you buy itNo: committed, not cost
ReceiptRecords a purchaseYes when assigned to the job, once; otherwise overhead or Multi-Job
Vendor billWhat you owe a vendorYes, once the goods or work are received or performed
PaymentThat you paid some or all of a billNo: it reduces what you owe
2What each entry includes

Three records, three sets of fields.

The vendor
FieldThis guideWhy
NameAlwaysWho you buy from or owe
Supplier or subcontractorAlwaysSeparates trade subs from suppliers
Default accountUsuallyCodes their purchases the same way every time
Phone and emailUsuallySending purchase orders, asking questions
NotesUsuallyWhat belongs with the vendor, such as a license number
A W-9, kept outside ClampFor a U.S. independent contractor you engage for servicesThe correct name and taxpayer number for information reporting
A written subcontract, kept outside ClampFor every subcontractorScope, payment terms, changes and what can stop payment (Stone)
License, bond or insurance evidence, kept outside ClampWhen the trade, the contract or the law requires itCheck before the sub starts

In Clamp, tax goes inside the purchase order's line amounts; a purchase order has no tax field.

The purchase order and the bill
FieldThis guideWhy
PO: job, vendor and PO numberAlwaysOne job, one vendor, a reference for every later record
PO: a description and amount for each lineAlwaysWhat you committed to, and for how much
PO: accountAlwaysThe kind of cost you expect
PO: estimate lineWhen the job has a matching lineConnects the commitment to what you estimated
PO: written specificationsFor subcontracted or specification-sensitive workSo the sub quotes and builds the same thing (Stone, chapter 9)
Bill: vendor, bill date, totalAlwaysWho is owed, when, how much
Bill: reference number and due dateUsuallyThe vendor's invoice number; without a due date a bill is never overdue
Bill: allocation (job, overhead or non-business; account; cost date)Always, for the part you assignWhere the cost belongs and when
Bill: work performedAlways, per allocationWhether the amount is job cost yet
Bill: the purchase order it billsWhen there was oneConnects ordered to billed
Bill: a paid receipt for the same purchaseWhen one was already recordedOne purchase, one cost
Bill: retainageWhen the subcontract provides for itSeparates earned cost from what is payable now
3How to record it
The vendor"Ridge Stone LLC", Subcontractor, default account Subcontractors. A W-9 and the signed subcontract are on file outside Clamp.
The written quoteBefore the purchase order, write the countertop specifications and get Ridge Stone's written price against them. Go through the quote line by line and ask about anything unclear. Keep the specifications and the quote as backup to your estimate (Stone, Estimating Construction Profitably, chapter 9).
The purchase orderPO-001 · 5x8 bathroom · Ridge Stone LLC. One line: "Stone countertop, fabricate and install (5.7 sf)" · $296.40 · Subcontractors · costed against the estimate's Stone Countertop Fabrication line. It covers both published countertop lines, fabrication at $171.00 and install at $125.40; Clamp ties a purchase order line to one estimate line.

This amount is committed, not cost.

The billWhen the countertop is set: Ridge Stone LLC · bill date October 2, 2026 · reference INV-1042 · total $296.40 · due November 1, 2026. Allocation: 5x8 bathroom · Subcontractors · cost date October 2 · work performed. Linked to PO-001.

Once the allocation is recognized, it is the job's actual cost. Paying the bill does not add it again.

Checking the billBefore you pay, check it against the subcontract, the purchase order and the work actually done.
The payment$150.00, by check #1311 from your business checking account, applied to INV-1042. Pay through a traceable business method and keep the record. Clamp records the payment; it doesn't move the money.

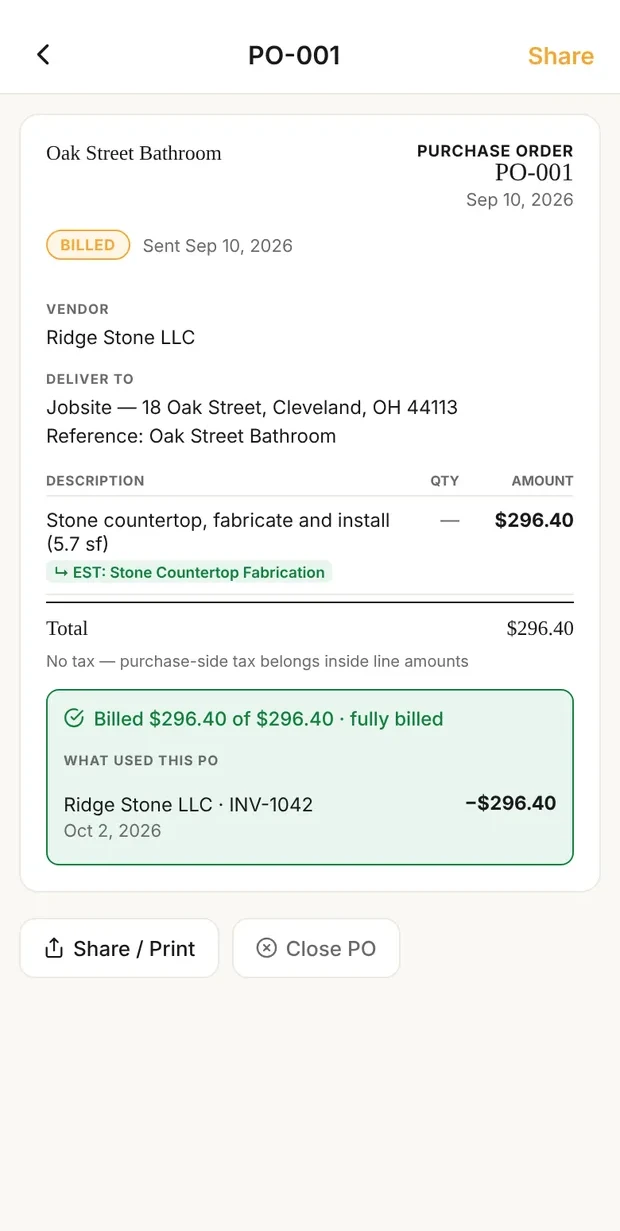

Clamp's PO-001 to Ridge Stone LLC for the Oak Street Bathroom: Stone countertop, fabricate and install (5.7 sf), $296.40, tied to the estimate's Stone Countertop Fabrication line; Billed $296.40 of $296.40, fully billed, by INV-1042 on Oct 2, 2026

The purchase order, billed

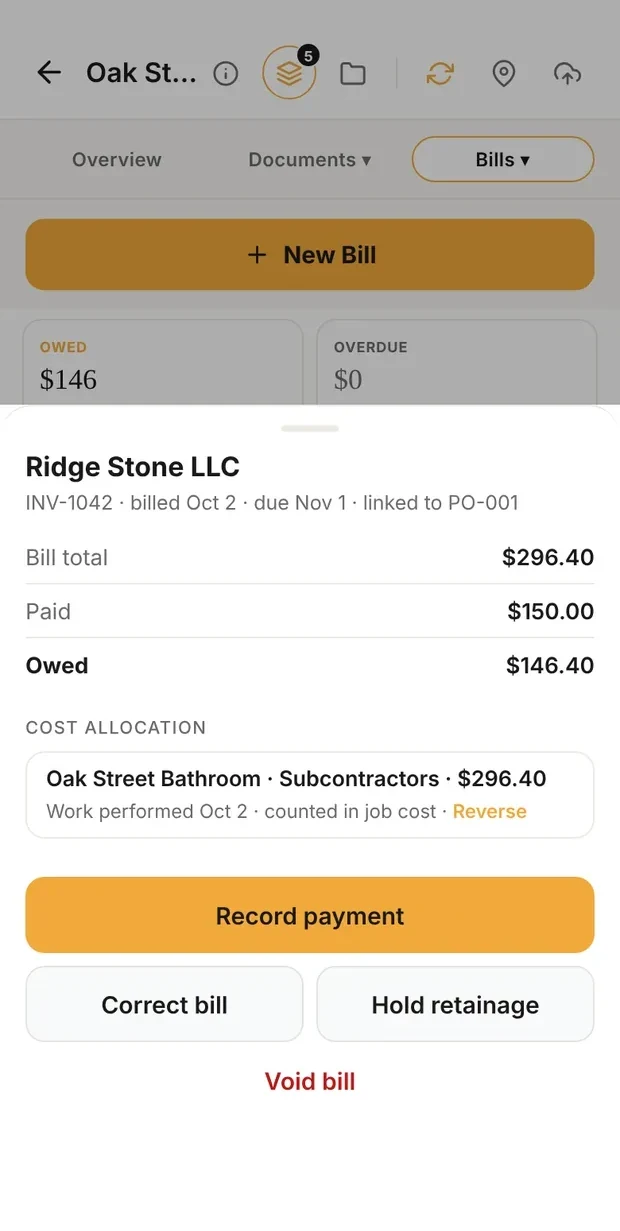

Clamp's bill from Ridge Stone LLC, INV-1042, billed Oct 2, due Nov 1, linked to PO-001: bill total $296.40, paid $150.00, owed $146.40; cost allocation Oak Street Bathroom, Subcontractors, $296.40, work performed Oct 2, counted in job cost

The bill, partly paid

The countertop sub's purchase order and bill in Clamp: the bill uses the order up, and the $150 payment leaves $146.40 owed. Demo data on the published 5x8 bathroom.

Who gets a purchase order. Special orders, subcontractors and other meaningful commitments. A routine counter purchase is a receipt.

Who gets a vendor record. Every subcontractor, and every supplier you buy from by purchase order, by bill, or often.

4The math

From the published 5x8 bathroom (Clamp Research). The countertop lines are published; the dates and the payment are an illustration.

One purchase, four numbers
Amount
Committed: PO-001 to Ridge Stone$296.40
Actual cost: INV-1042, work performed and recognized$296.40
Still on order: PO-001$0.00
Paid so far$150.00
Owed: INV-1042 balance$146.40

Committed, actual cost, owed and paid are four different numbers. Only actual cost is job cost.

CommittedWhat is still on order on the purchase order.
Actual costJob-assigned receipts and recognized job-bill allocations.
OwedRecognized bills not yet paid.
PaidPayments recorded.

Clamp's job costs screen labels actual cost "Spent", even when the bill isn't paid yet.

A paid receipt meets a bill. You bought the tile setting materials at the counter and logged the receipt: $86.96 on the company card. If the supplier's monthly bill later lists the same purchase, match the bill to the paid receipt. That matched transaction is one cost and one existing settlement, not a second cost or a second payment.

Retainage, if your subcontract has it. The recognized subcontractor cost can be $296.40 while only $266.40 is payable now, because $30.00 is held until the agreed release condition. The $30.00 is an illustration, not a recommended amount. Whether you hold retainage, how much, and when it is released are set in the subcontract. State prompt-payment and retainage law can govern all three. Check your state and have your agreement reviewed.

5What makes it hold up

One economic cost enters job cost once. A purchase order is a commitment, a recognized bill is cost, a paid receipt records the cost and its existing settlement, and a payment settles what you owe. Matching a receipt to a bill makes them one cost and one settlement.

The paper trail. Where the records exist, link them, so you can trace the purchase from the agreed scope or commitment through the bill or receipt to the payment, and show why you paid what you paid.

What a sub's bill should tie to. The vendor, the agreed scope or purchase order, the amount, the job, the date, and evidence the work was done. This is this guide's practice; Stone's support is upstream, in a written scope and a written price.

Tax information. Once you've determined that the person you're paying is an independent contractor, the IRS says the first step is to have the contractor complete Form W-9. It gives you the correct name and taxpayer identification number, and the IRS says to keep it in your files for four years. For payments made in 2026, the federal Form 1099-NEC threshold for qualifying nonemployee compensation is generally $2,000 (it was $600 for payments before 2026, and it is adjusted for inflation after 2026). Entity type, payment method, backup withholding and other rules can change whether a form is required. Confirm your year-end process with your tax professional. Clamp doesn't track W-9s or prepare 1099s.

Then compare. Recognized costs feed the job's estimated-vs-actual. Michael C. Stone, a builder and remodeler with more than six decades in the industry, says in Estimating Construction Profitably (chapter 12) that this comparison, by estimate section, is how estimates get better. The method is in How to Job Cost a Remodeling Job.

6The policy decisions

Decide these before the first purchase order.

Purchasing policy
DecisionThis guide's practiceWhy
Which purchases get a purchase orderSpecial orders, subcontractors and other meaningful commitmentsControls the purchases most likely to move cost or schedule, without paperwork for every counter buy
When a bill is job costWhen the goods or work it bills are received or performedJob cost follows the work, not the mail or the bank
Retainage on subcontractorsOptional, set in the subcontractIt holds part of the payment until a stated condition; state law can govern it
When vendors and subs are paidOn the agreed terms, after checking the bill against the scope and the workPredictable for both sides. Stone puts payment terms in the sub agreement and rejects "I can't pay you until I've been paid" (Markup & Profit, chapter 6)
Who gets a vendor recordEvery subcontractor; suppliers you buy from by PO, by bill or oftenVendor history where it matters, without a record for every one-off store
7Where it goes next
Job costRecognized bills are actual cost; open purchase orders are committed. See How to Job Cost a Remodeling Job.
Close the purchase orderWhen nothing more is coming, so the job doesn't carry a commitment that is already filled.
The accountant exportJob costs with PO numbers, an accounts-payable aging schedule, and bill-receipt matches.
A change orderWhen a vendor cost changes the customer's scope. See How to Write and Price a Change Order.
8Mistakes

What people get wrong with purchase orders, bills and vendors, and what to do instead.

Purchasing mistakes
MistakeInstead
Treating a purchase order as costIt is committed until a receipt or a recognized bill makes it actual cost
Recording a receipt and its matching bill as two costsMatch them: one purchase, one cost
Adding a payment to job costA payment reduces what you owe; the bill already made the cost
A sub starting from a verbal scopeWritten specifications and a written quote (Stone, chapter 9)
Accepting a sub's quote without checking what it includesGo through it and ask (Stone, chapter 9)
No payment terms in the sub agreementSay when and how the sub is paid and what can stop payment (Stone, Markup & Profit, chapter 6)
Telling a sub they'll be paid when the customer paysPay on the agreed terms, subject to state law (Stone, Markup & Profit, chapter 6)
Paying without checking the billCheck it against the agreement, the purchase order and the work first
Leaving finished purchase orders openClose them so committed cost isn't overstated
No due date on a bill that has oneEnter it, so owed and overdue mean something
Recording a bill but never recognizing the job's partRecognize it when the goods or work are received or performed
Waiting until year end for the W-9Get it when you set up the sub; the IRS calls it the first step
Using the old $600 threshold for 2026 paymentsGenerally $2,000 for payments made in 2026, subject to the IRS rules

What it means

What this saysA commitment is not a cost, and a cost is not a payment. Record each event once, linked: the purchase order, the bill or receipt, and the payment. Then you can see what is committed, what the job actually cost, what you owe and what you have paid, without counting a dollar twice.
A commitment is not a cost, and a cost is not a payment.

Purchase orders, bills and vendors in Clamp

Each vendor is a supplier or a subcontractor, with contact details, notes and a default account, and its screen shows what you've spent with them by job and what you owe. Each purchase order belongs to one job, with lines you can tie to the job's estimate; job costs shows it as "Ordered, not billed", never as spent, and receipts and bills draw it down until it reads fully billed. Allocate a bill to one or more jobs, overhead or non-business, mark when the work was performed, link it to the job's purchase orders, and match a paid receipt so the cost and payment count once. Record payments in full or in part, from your payment accounts. On a subcontractor bill you can hold retainage and release it later. Clamp doesn't pay vendors, sync with QuickBooks, track W-9s, 1099s, insurance certificates or lien waivers, or put line items on a bill.

Read How to Track Job Receipts for what each purchase record must show, and score your Operations system in the contractor business self-assessment.
