model

How to Track Job Receipts: What Each One Must Show, and Where It Goes

Record every receipt the same day, while you still know what it was for. What each entry must show, a published tile line bought, returned and compared with the estimate, what the IRS asks for, and where each receipt goes next.

Direct answer: Record every receipt the same day, while you still know what it was for. Give it a date, the merchant, the total, a description, a category, and the job it belongs to, or mark it overhead, and keep the image. Tie each job purchase to the estimate line it was bought for. Then job cost stays true while the job is still running, and the receipt holds up when the IRS, a customer or your next estimate asks what it was.

The assumptions

This model assumes

  • A residential remodeler buying materials for jobs, alone or with a small crew
  • The estimate line is from the published 5x8 bathroom, version 3; the purchase and the return are an illustration
  • Sales tax is left out of the illustration, as the published estimate leaves it out
  • Recordkeeping guidance, not tax advice; confirm retention with your tax professional

The model, step by step

1Where it sits

A receipt is one piece of evidence. Job cost is what it becomes once it is assigned to the right job and the right line.

The receipt against the records it gets confused with
RecordWhat it is
ReceiptA record supporting a purchase, whether it was paid now or charged to an account.
Vendor billAn amount the business owes a vendor and tracks for later payment. See the bills guide.
Purchase orderA purchase you agreed to before buying.
Job costWhat the job's receipts, bills and labor add up to. See What is job cost.
2What each entry includes

Clamp saves a receipt with only a total. That is the app's minimum, not a good record.

What a receipt entry includes
FieldThis guideWhy
TotalAlwaysThe amount spent
MerchantAlwaysWho sold it. IRS supporting documents identify the payee
DateAlwaysWhen the expense was incurred
DescriptionAlwaysWhat was bought and for what, so the cost can be assigned and its business purpose shown
CategoryAlwaysWhat kind of cost it is in the books: materials, dump fees, office supplies
Job, Overhead or Multi-JobAlwaysWhere the cost belongs
The imageUsuallyA copy of the supporting document
Paid withUsuallyCard, cash, check, paid personally or on account; separates business from personal money
Subtotal and taxUsually, when the receipt shows themBookkeeping detail
VendorWhen it differs from the merchant name or you buy there oftenVendor history and, later, bill matching
Estimate lineWhen it is a job cost on a job with an estimateMakes estimated vs actual possible
Purchase orderWhen a PO authorized the purchaseConnects the purchase to the prior commitment and its remaining balance
ReturnWhen goods go backA linked negative entry; the original stays as it was
3How to record it

The same day, by the person who bought it. On a crew, the buyer captures and codes the receipt before the end of the day; the office reviews the exceptions. IRS Publication 583 says to record transactions as they occur, and that daily is generally best. Michael C. Stone, a builder and remodeler with more than six decades in the industry and the author of Estimating Construction Profitably, is blunter about why (chapter 12): an estimated-vs-actual comparison breaks down when whoever enters the cost doesn't know which part of the job a purchase was for.

A filled example from the published 5x8 bathroom:

Merchant"Lakeshore Tile Supply." Who sold you the goods or service.
Date"September 21, 2026." When you bought it.
Total$231.00. Subtotal $231.00; tax $0.00 in this illustration, which leaves sales tax out as the published estimate does.
Description"Porcelain floor tile, 4 boxes (44 sf), 5x8 bathroom." Enough that someone six months from now knows what and why.
Category5200, Materials. What kind of cost it is.
Belongs toThe 5x8 bathroom job. Not overhead, not Multi-Job.
Costed againstBathroom Tile Material Allowance, 30.8 sf. The estimate line this purchase tests.
Paid withCard. How it was paid, or whether it went on account.
ImageThe whole receipt, flat, in good light.

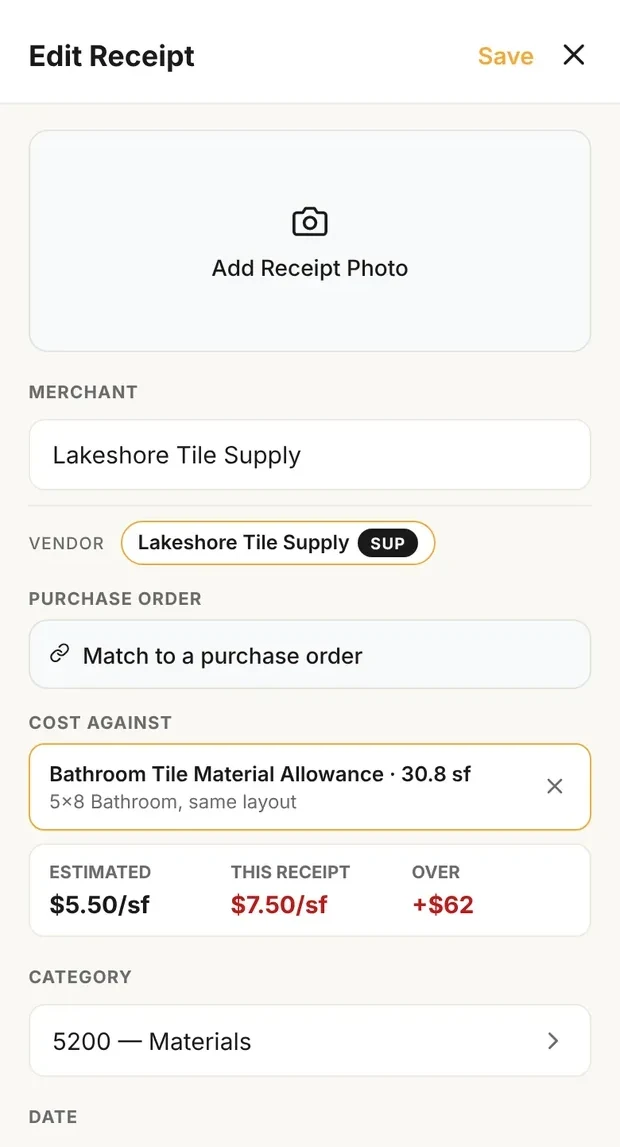

Clamp's Edit Receipt for Lakeshore Tile Supply: cost against Bathroom Tile Material Allowance, 30.8 sf, on the 5x8 bathroom estimate; estimated $5.50/sf, this receipt $7.50/sf, over +$62; category 5200 Materials

Costed against the estimate line

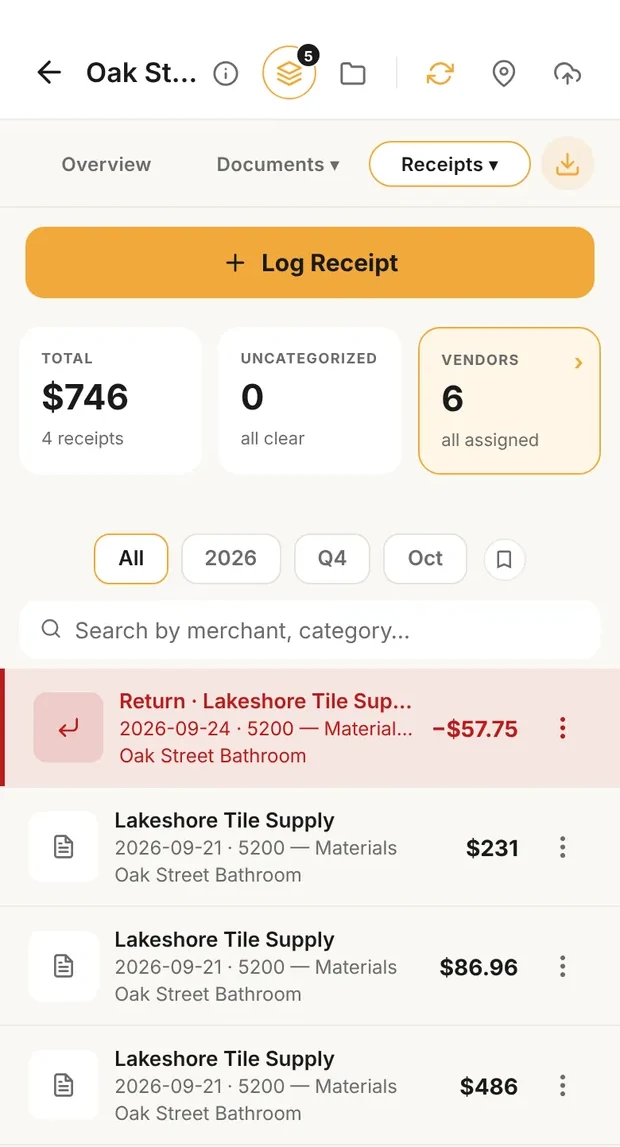

The Oak Street Bathroom job's receipts: total $746, 4 receipts, none uncategorized; a return of $57.75 to Lakeshore Tile Supply on Sep 24 listed above the $231, $86.96 and $486 purchases of Sep 21, all 5200 Materials

The return, its own entry

The floor tile receipt in Clamp, costed against the estimate's tile allowance line, and the job's receipts with the return as its own entry. Demo data on the published 5x8 bathroom.

Job or overhead? Tile set on the bathroom is job cost. Printer toner for the office is overhead. Which account a cost uses is covered in What is job cost and the overhead categories.

One purchase for several jobs. Clamp can't split one receipt across jobs. Ask for a separate ticket for each job at the register. When one receipt covers several jobs, log it to Multi-Job. Because a Multi-Job receipt is not assigned to an individual job, it can't make any one job's estimated-vs-actual complete. If accurate per-job costing matters, ask for separate tickets.

Paid personally. Log it the same day as "Paid personally", not after you pay yourself back. Waiting leaves the job's cost short in the meantime.

4The math

From the published 5x8 bathroom (Clamp Research). The purchase and the return are an illustration; the estimate line is published.

The estimate carries 30.8 sf of floor tile at $5.50 = $169.40: the 28 square feet of floor plus waste.

You buy 44 sf, four boxes, at $5.25 = $231.00. Clamp compares this receipt with the line: it divides the $231.00 by the line's 30.8 sf and shows $7.50/sf against $5.50/sf estimated, $62 over.

One unopened box, 11 sf, goes back for $57.75. The return is its own entry, linked to the original.

$231.00 - $57.75 = $173.25

Net job cost for the line is $173.25, $3.85 over the $169.40 estimate. You paid less per square foot than estimated, but bought whole boxes.

Two questions, two answers. The variance tells you whether this line cost more or less than you estimated, which is a lesson for your next estimate. What the customer owes for a selection that ran over the allowance is a different question, answered by the signed agreement and a change order (How to Write and Price a Change Order). A receipt is evidence of cost. It is not, by itself, a bill to the customer.

5What makes it hold up

For the IRS. The IRS doesn't prescribe a receipt format. Keep enough supporting records to identify the payee, amount, proof of payment, date incurred, and the item purchased or service received, showing that the amount was for a business purchase or expense (IRS, "What kind of records should I keep?"). One receipt may show most of that; another record, such as a card statement or canceled check, may be needed to prove payment. Proof of payment alone does not establish the expense (Pub. 583). Keep records for the applicable IRS limitations period, commonly three years for ordinary return-supporting records, and longer when special rules apply. Confirm your retention policy with your tax professional.

The paper. A receipt photo can be part of a compliant electronic recordkeeping system, but taking a picture does not by itself establish that the system meets the IRS electronic-storage requirements (Rev. Proc. 97-22). This guide keeps the paper until your tax professional approves a photo-only process.

For a customer dispute. The receipt is evidence of what you bought. Under this guide's contract process, the chain that settles an allowance question is the signed allowance baseline, the purchase evidence, any return or credit, the resulting difference, and the signed change order that adjusts the customer's price.

For a job-cost review. A receipt holds up when it carries the job, the category, the estimate line, the amount, the date and the description. Then you can say: we estimated this, we spent this, here is the evidence. Stone (chapter 12) says the only way to improve estimate accuracy is to know how the finished job's actual cost compared with the estimate. The method is in How to Job Cost a Remodeling Job.

6The policy decisions

Decide these before the first receipt.

Receipt policy
DecisionThis guide's practiceWhy
When receipts are loggedThe same dayThe purpose is still fresh (IRS Pub. 583: daily is generally best)
Who logs them on a crewThe buyer; the office reviews exceptionsThe buyer knows what it was for
One purchase for several jobsA separate ticket per job; otherwise Multi-JobClamp can't split one receipt
Paid personallyLogged the same day as "Paid personally"The job's cost isn't short while you wait to be repaid
The paper after the photoKept until your tax professional approves photo-onlyElectronic records have their own IRS requirements
7Where it goes next
Job costBudget against actual, while the job is running. See How to Job Cost a Remodeling Job.
A change orderWhen a selection runs over its allowance. See How to Write and Price a Change Order.
The accountant exportAt tax time.
A vendor billA paid job receipt can settle a bill from the same vendor. See How to Track What a Job Costs Before You Pay It.
8Mistakes

What people get wrong with receipts, and what to do instead.

Receipt mistakes
MistakeInstead
Reconstructing purchases at the end of the weekLog it the same day (IRS Pub. 583)
A photo with no descriptionSay what it was and what it was for
Everything coded "Materials" with no jobAssign the job and the estimate line (Stone, chapter 12)
Job materials in overhead, or office costs on a jobUse the same job and overhead definitions every time
Losing purchases paid personallyLog them as "Paid personally" the same day
Editing the original when goods go backRecord the return as its own entry
Treating a receipt as proof the customer owes an overageThe signed agreement and a change order decide that
Keeping only proof of paymentKeep the purchase evidence too; proof of payment alone does not establish the expense (Pub. 583)
Throwing out the paper once it is photographedKeep it until your tax professional approves photo-only (Rev. Proc. 97-22)
Recording costs and never comparing them to the estimateEach receipt can show its estimate line's over or under; review estimated vs actual by estimate section regularly (Stone, chapter 12)

What it means

What this saysRecord it while you still know what it was for: the same day, with the job, the category and the estimate line. A return is its own entry. Then the job's cost stays true while it runs, and the receipt holds up when the IRS, a customer or your next estimate asks what it was.
Record it while you still know what it was for.

Receipts in Clamp

"Take a photo" reads the merchant, total, subtotal, tax, date and a suggested category on your phone. It works offline, with no subscription, and anything it can't read is marked to fill in before you save. Every receipt is attached to a job, to Overhead or to Multi-Job. On a job with an estimate, "Cost against" ties the receipt to one estimate line and shows the rate you paid against the rate you estimated. Match a receipt to an open purchase order, and a paid job receipt can settle a bill from the same vendor. "Record a return" adds a linked entry with a date and a reason, and the original isn't changed. Each job's receipts export as a spreadsheet or a PDF report laid out for tax records. Clamp doesn't connect bank or card feeds, sync with QuickBooks, take emailed receipts or split one receipt across jobs.

Check what goes in job cost in What is job cost, and score your Operations system in the contractor business self-assessment.
