model

How to Write and Price a Change Order

A change order is a signed amendment to the contract. What it includes, how to write each section, how to price work added and credit work removed, and the rule that protects you: no signed change order, no changed work.

Direct answer: A change order is a signed amendment to the construction contract. It says what changed and why, prices the work added and credits the work removed, and shows the contract price before and after the change, its effect on the schedule, and how the change will be paid. The customer and the contractor both sign it before the changed work starts. If it is not approved by its deadline, the original contract stays in force and the changed work is not authorized.

The assumptions

This model assumes

  • A residential remodel with a signed contract
  • Pricing the extra risk of a change is covered in Three markups, one job cost
  • The owner's practice: removed work credited at its sold price, every change signed before the work, a three-day deadline
  • Sample language is a drafting example, not legal advice. Have your final form reviewed in your state.
  • The $40,000 average project and the 1.76x and 1.50x markups are published Clamp model figures; the quantities are an illustration

The model, step by step

1Where a change order sits

A change order amends a signed contract, one change at a time.

Four documents, four jobs
DocumentWhat it does
Proposal or contractSets the scope, price, schedule and payment terms
Change orderAmends them, one change at a time, signed before the work
Allowance adjustmentReconciles an allowance when the selection costs more or less than the amount in the contract. If the selection also changes labor, scope or schedule, those changes need a change order
InvoiceBills the work, including any signed changes

Not every request is a change. If the work is already in the signed scope, it is not a change order. If it adds to, removes from or modifies the agreed work, it is one. And something you left out of your own estimate for work you already promised is not a change the customer pays for.

Michael C. Stone, a builder and remodeler with more than six decades in the industry and the author of Markup & Profit: A Contractor's Guide, Revisited, the book this guide draws on, recommends explaining the change-order process before the original contract is signed. Then the first change is a step the customer already expects.

2What it includes

Every change order needs eight things.

What goes in, and how often
ItemInclude
A change order number and date, and the contract it amendsAlways
The reason for the changeAlways
The work added, written as the operations to be doneAlways
The work removed, named, not just shown as a creditAlways
Three dollar figures: this change, the contract price before it, the contract price after itAlways
The schedule effect, in days, even when it is zeroAlways
How the change will be paidAlways
Signatures from the customer and the contractorAlways
An approval deadlineUsually
Sales tax, where it applies to your workDepending on the change
Permit, engineering or design changes the work requiresDepending on the change
A design or estimating fee, when pricing the change takes real drawing or estimating workDepending on the change
Photos of the field condition, for a discovered conditionDepending on the change

Stone treats the three dollar figures as the critical disclosure: the price of the change alone does not tell the customer what the contract now costs.

3How to write it, section by section

The language below is a drafting example, not legal advice. Have a lawyer in your state review your final form.

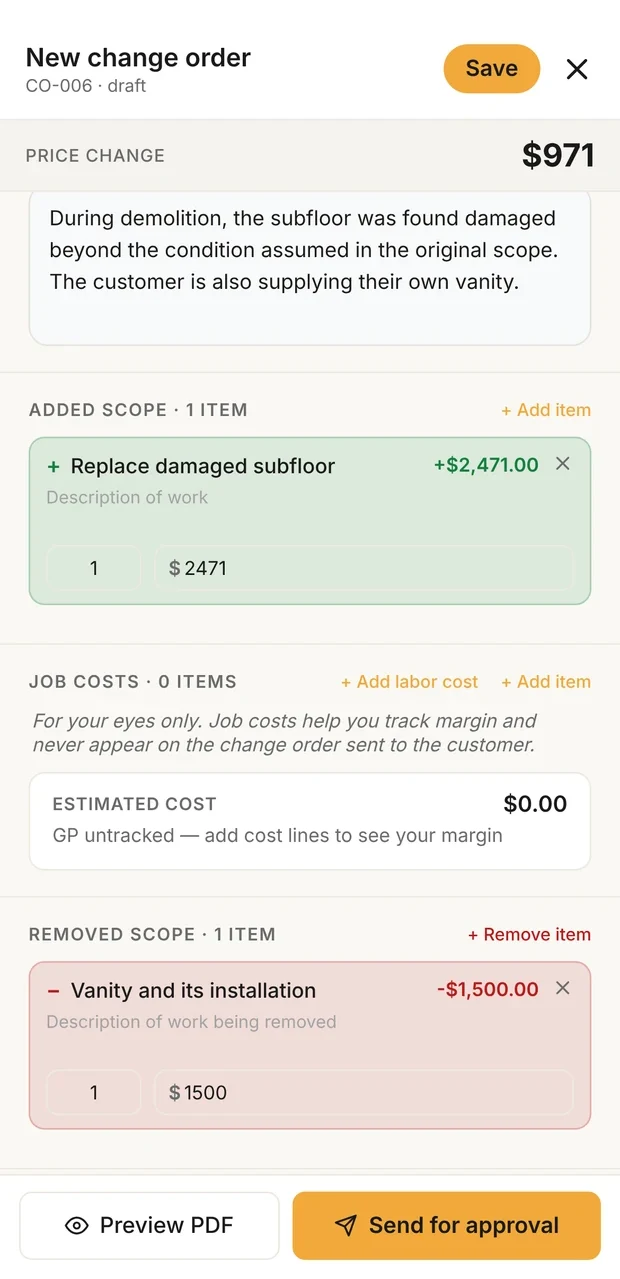

Clamp's change order form showing the reason, an added line for replacing damaged subfloor at $2,471 and a removed line for the vanity at minus $1,500

Work added and removed

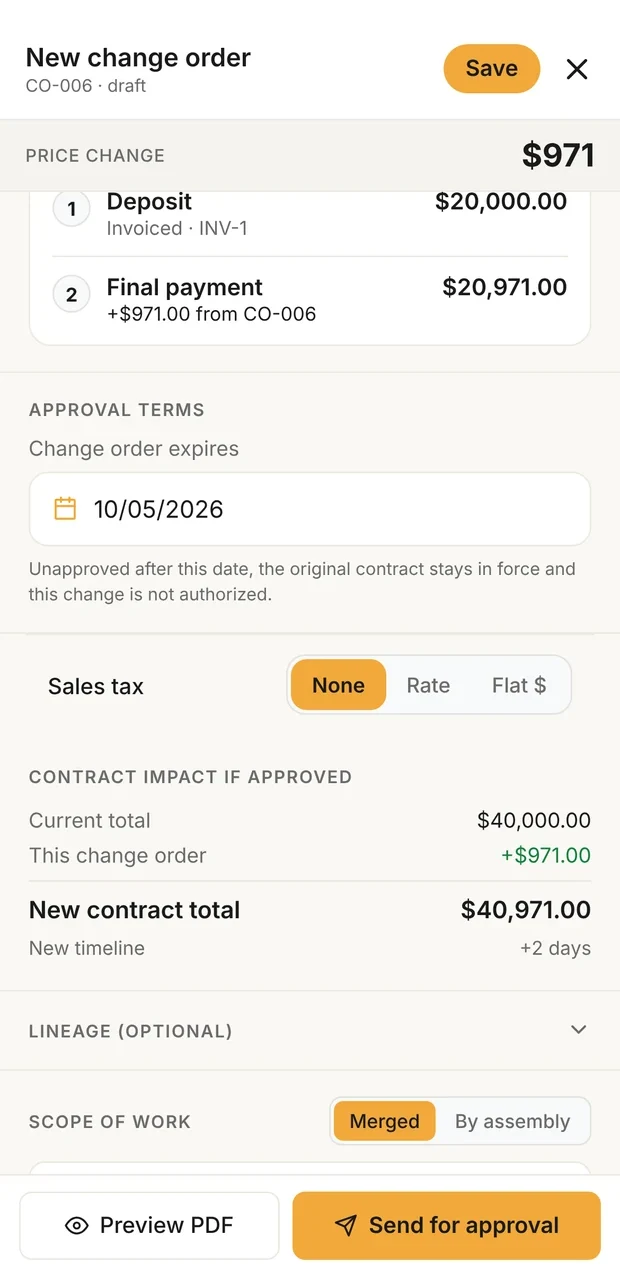

Clamp's change order form showing a three-day expiration, the line that the original contract stays in force if unapproved, and the contract impact: current total $40,000, this change order plus $971, new contract total $40,971, plus 2 days

Deadline and contract impact

A change order in Clamp: the work added and removed on the form, then the approval deadline and the contract impact. Demo lead; the figures are the worked example in step 4.

ReasonSay what happened and which kind of change it is: a discovered condition, a scope addition, a selection change, or a permit or inspection requirement. For example: "During demolition, the existing subfloor was found damaged beyond the condition assumed in the original scope. This change order prices the removal and replacement required before flooring can continue."
Work addedWrite the work as operations, not as "extra labor and materials". For example: "Remove the damaged subfloor in the affected area; furnish and install new plywood subfloor; prepare the area for the originally contracted flooring."
Work removedName what leaves the agreement. For example: "Delete the originally specified vanity and its installation."
PriceShow all three figures: "Price of this change: +$____. Contract price before this change: $____. Contract price after this change: $____." A change that only removes work shows a negative price, which is a credit.
Schedule effect"This change [adds / removes] about ____ working days [or: does not change the schedule]. The revised anticipated completion date is ____."
Payment"The amount of this change will be [added to the next scheduled payment / added to the final payment / billed on its own], as shown in the payment schedule below."
Approval deadline"This change order is valid through [date]. If it is not approved by then, the original contract remains in force and the changed work is not authorized."
Signatures"By signing, Customer and Contractor agree to the changed scope, price, schedule and payment terms stated here. Except as changed here, the original contract remains in force."
4How to price it

Price the work added at your change-order markup. Credit the work removed at the price it was sold for. Three markups, one job cost explains why a change carries 10 more points of net profit than the original job. This example reuses its figures, on the Established profile, against the published $40,000 average project from What a Solo Contractor Has to Charge. The quantities are an illustration.

A worked example: one change, added and removed work
LineJob costMarkupPrice
Work added$1,4001.76x$2,471
Work removed, credited at its sold price$1,0001.50x−$1,500
Price of this change$971
$40,971 = $40,000 + $2,471 − $1,500

Under this guide's deduct policy, removed work is credited at the price it was sold for. If costs have already been incurred for work that is later removed, identify them separately under your written deduct policy rather than treating the work as never started. The added work carries the change-order markup because it is being introduced after the original job was priced and scheduled.

In this guide's practice, routine pricing and coordination are covered by the change-order markup. When a change needs separate drawings, engineering or substantial estimating, that work is billed on its own, before the change is priced. Stone recommends charging for design, drafting, estimating and coordination work on a change, even one the customer declines.

The three figures on the change order
ContractAmount
Contract price before this change$40,000
This change+$971
Contract price after this change$40,971
5No signed change order, no changed work

This is the rule that protects you. Nobody on the job changes the work until the change order is signed: not you, your crew, your subcontractors or your suppliers. Stone is explicit that work outside the signed contract needs a signed change order first.

When the customer asks for something different on site, stop at the decision point. Say yes, you can look at it, and that you will price it and write it up before the original scope changes. Then define the change, price the work added and removed, show the schedule and payment effect, and get it signed.

A verbal or text approval records the conversation. It does not amend the contract, and it does not authorize the work.

Signing authorizes the change. Payment then follows the method written on the change order, under your contract and your state's law.

A delayed decision can cost money. If waiting to approve a change creates extra work, Stone's practice is to write a new change order with the added cost.

6The policy decisions

Write your choices into the contract, so the customer knows them before the first change comes up.

This guide's practice
DecisionPracticeWhy
Small changesEach one gets its own signed change order, before the workBatching means doing unapproved work
SignaturesThe customer and the contractorStone's contract language calls for one signature from each party
Verbal approvalRecords intent onlyThe contract changes only when the change order is signed
Credit for removed workThe full price it was sold forThe customer gets back what they paid for that work. Costs already incurred are handled under your written deduct policy
Fee to price a changeNone on ordinary changes. Design and estimating time is billed when a change needs itThe change-order markup covers routine pricing
Approval deadline3 days, adopting Stone's recommendationA short deadline keeps the job from stalling while a decision waits
Where credits are appliedStone applies them at final payment rather than to progress paymentsThat is his policy, not a legal rule
7After it is signed

The signed change becomes part of the contract price, and the next invoice and the payment schedule reflect it. How to set a payment schedule and invoice a remodeling job covers the invoice itself. The payment follows the method written on the change order: the next payment, the final payment, or its own invoice.

If it is not signed by the deadline, it lapses. The original contract stays in force and the changed work is not authorized. Work continues on the original scope wherever it can proceed without the unresolved change. A discovered condition that stops the original work stays a decision point until it is resolved. If the customer still wants the expired change later, issue a new or revised change order at the current price and schedule effect.

8Objections, and the usual mistakes

Most objections are answered by the signed contract and the change order itself.

What the customer says, and what to say back
The customer saysWhat to say back
"I thought that was included."Compare the request to the signed scope. If it is included, it is not a change. If it is not, write the difference down before going further.
"Why does a small change cost so much?"A change in the middle of a job can require new pricing, ordering, scheduling and coordination, and can interrupt the planned sequence. Stone notes that a change often costs more than the same work would have cost in the original scope.
"Just do it and add it to the end."The work continues under the signed contract until the change is approved. Doing it first removes the protection both of you have.
"We agreed to this yesterday."The conversation started the change. Signing the change order completes it.
"Can't we decide later?"You can, if the original work can continue without closing off the decision. If waiting creates rework or delay, the change is repriced when you decide. Until then, the original contract stays in force and the change is not authorized.
"Why am I paying for you to price this?"Only changes that need drawings, engineering or a full estimate carry a fee, and that work costs money whether or not you go ahead.
The usual mistakes, from Stone
MistakeInstead
Starting changed work before the change order is signedSign first, then change the work
Letting the crew, subcontractors or suppliers accept changes informallyRoute every change through you
Showing only the price of the changeShow the contract price before and after
Ignoring the scheduleState the schedule effect, even when it is zero
Pricing a change as if it had been in the original jobUse your change-order markup
Doing design or estimating work on a change for freeBill it when the change needs it
Leaving removed work off the paperName it and credit it
Not explaining the change process before the contractExplain it at the contract
Leaving expected work out of the proposal to sell it laterPrice it in the proposal
Not repricing when a delayed decision costs moreWrite a new change order

What it means

What this saysA change order is the contract changing in writing before the work does. Show what changed, what it costs, what the contract total becomes and what happens to the schedule, get both signatures, then change the work.
No signed change order, no changed work.

Change orders in Clamp

A change order in Clamp lists the work added and the work removed, shows the contract before and after and the schedule effect, and sets how it is paid: added to the final payment, added to the next payment, or billed on its own. Only a signed change order changes the contract total, and a change order sent for signature asks for your countersignature by default.

See why a change carries 10 more points in Three markups, one job cost, and score your Operations system in the contractor business self-assessment.
