model

How to Set Construction Milestones: Where to Divide the Job and How to Define Each Stage

A milestone is an event in the job, with evidence it happened, that something else depends on. What a good milestone includes, sample wording from the trigger to the start notice, the published bathroom divided into its stages, and the rule that protects you: every payment milestone is an event, never a percentage complete or a calendar date.

Direct answer: A milestone is an objectively identifiable event in the job, with evidence it happened, that something else depends on: a payment, a notice, an inspection, or the next trade. Get milestones right in five steps: divide the job where the work visibly changes; write each payment trigger in the signed agreement as an event, never a percentage or a date; decide before the job starts whether each stage is due when it starts or when it's done; keep dated evidence that you reached it; and when the date slips, move the planned date and leave the event alone. The event defines the milestone. The date only predicts when you'll reach it.

The assumptions

This model assumes

  • A residential contractor (remodeling, specialty trade, service or new construction), solo or with a small crew and trade subs
  • The worked example is the published 5x8 bathroom, version 3, with the payment schedule from the invoice guide
  • The 14-day delay is an illustration
  • Sample language is a drafting example, not legal advice; home improvement payment law varies by state

The model, step by step

1Where it sits

What a milestone is for, against what it gets confused with.

The milestone against what it gets confused with
ThingWhat it is for
The milestoneThe event that has been reached: "demolition starts", "rough inspection passed".
The paymentWhat the milestone makes due. How much, and the start-or-done rule, are in the invoice guide.
The planned dateYour forecast of when you'll reach the event. It can move without changing the milestone.
The production scheduleWho works when. A schedule item may start a milestone; it isn't one. See how to coordinate a jobsite.
The inspectionThe building department's check. It can be a condition inside a milestone, or separate from payments.
The checklistYour record of what was completed toward a milestone. It documents the trigger and never redefines it.
The punch listThe remaining contract items at the end. See closeout.
2What a good milestone includes

Sorted from always to only if required.

What a good milestone includes
ItemWhenWhy
A nameAlwaysBoth sides need one stage to point at.
An objective triggerAlwaysSays exactly what event has been reached.
Trigger typeAlwaysState exactly what event controls it: signing, a start, completion, inspection or acceptance, or another defined event. For a production stage, start or done is the choice: "demolition starts" and "demolition is complete" are weeks apart.
What depends on itAlwaysA payment, a notice, an inspection, the next trade, a draw or closeout. A milestone with nothing depending on it is just a task.
The trigger written into the signed agreementAlways, when money or contract rights depend on itA checklist written later can't repair a vague signed term.
A "what has to be done" checklistUsuallyRecords the parts behind a "done" milestone.
A planned dateUsuallyFor planning. It can move without changing the milestone.
A start noticeUsually, for a stage that's due when it startsDated evidence the stage began.
PhotosUsually, when they show somethingEvidence of the condition at start or completion.
An inspection resultWhen passing it gates the next phaseEvidence the gate was cleared.
A sub's or crew's startWhen their work defines the stageOften the most visible event.
A selection deadlineWhen a customer decision gates productionSometimes the decision is what lets the next stage start.
A lender drawWhen the job is financed with drawsThe lender's draw rules apply, not yours.
Customer sign-off on the stageOnly if the contract, a lender or state law requires itThe default is the signed agreement plus your dated record.

The agreement defines the event. The checklist and evidence show you reached it.

3How to set them, step by step

The lines below are this guide's examples to adapt, not a script or legal advice. Have your payment terms reviewed in your state.

Divide the job"We divide this job where the work visibly changes: demolition and rough-in, then finishes, then fixtures and trim, then closeout. Each stage has one event that tells us it has started or finished."
Write the trigger"Payment 2 is due when demolition and rough-in start."

Not "when rough-in is mostly complete". For a stage that's due when it's done, name the finished condition: "Payment 2 is due when rough plumbing and electrical are complete and the rough inspection has passed."

Michael C. Stone is a builder and remodeler with more than six decades in the industry, and the author of Markup & Profit: A Contractor's Guide, Revisited. He ties progress payments to the start of clearly identified segments, such as framing, rough plumbing or cabinet installation, because a start is easier to agree on than how complete something is.

Write the checklist"For this stage we track: demolition complete; plumbing rough complete; electrical rough complete; rough inspection passed."

The checklist records how you support the trigger. It doesn't rewrite the signed trigger.

Send the start notice"Demolition and rough-in are planned to start Monday, October 12. Under our agreement, payment 2 is due when that stage starts."
Report completion"This stage is complete. The checklist shows each item and the date it was done, with photos. Under our agreement, [the next payment or step] now applies."

Say what you reported. Don't say your software confirmed the work.

Move the date"Demolition and rough-in are now planned for Wednesday, October 14. The payment trigger hasn't changed: it's due when that stage actually starts."
A failed inspection"The rough inspection didn't pass, so this stage isn't done yet. We're correcting the listed item and will update the planned start of the next stage after the reinspection."
A change that adds a stage"This signed change adds [the work]. It also adds a payment of [amount], due when [event], before [the following stage]."

The signed change order updates the agreement before that work starts. See the change order guide.

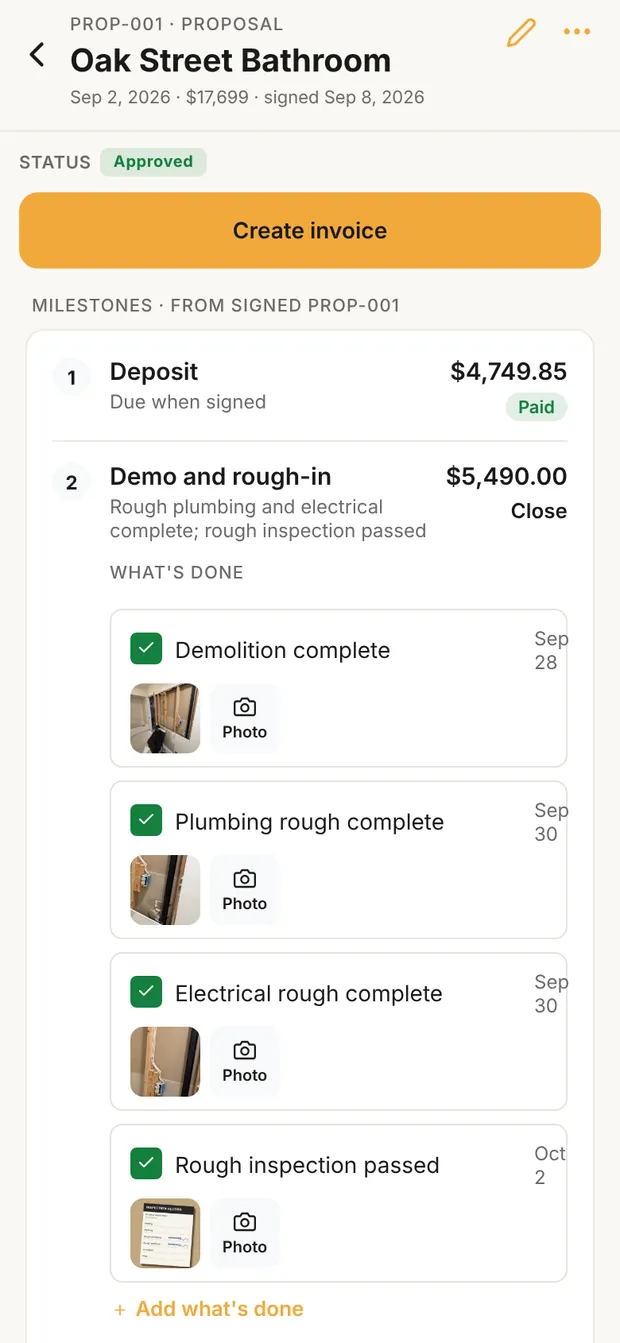

Clamp's milestones for the Oak Street Bathroom from signed PROP-001: the deposit, $4,749.85, paid; Demo and rough-in, $5,490.00, due when rough plumbing and electrical are complete and the rough inspection has passed, open to What's done with four checked lines, each with a photo: demolition complete Sep 28, plumbing rough complete Sep 30, electrical rough complete Sep 30, rough inspection passed Oct 2

The checklist, with photos

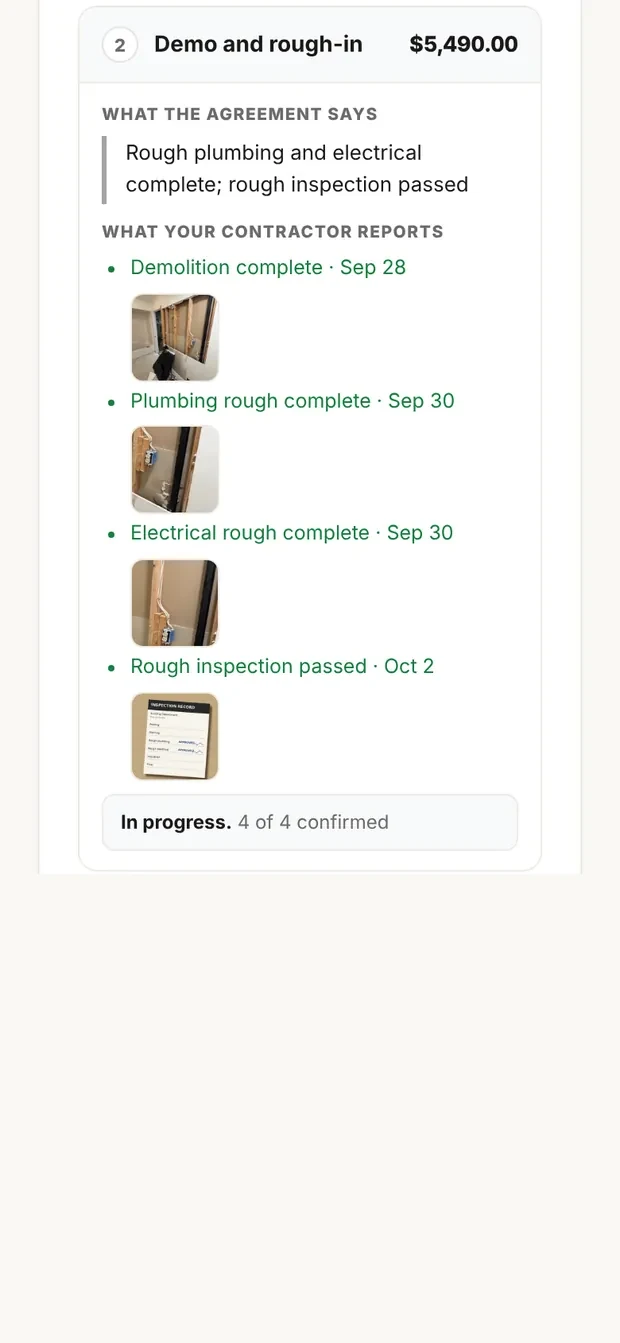

The customer portal's Demo and rough-in milestone, $5,490.00: what the agreement says, rough plumbing and electrical complete and rough inspection passed; what your contractor reports, the four dated lines each with its photo, including the signed inspection card; in progress, 4 of 4 confirmed

What the customer sees

The rough-in stage's "What's done" checklist in Clamp, each line with its date and a photo, and the same lines with their photos in the customer's portal, under "What your contractor reports". Demo data on the published 5x8 bathroom.

The hard case: the customer says the stage isn't done"I don't think this stage is finished."

Answer with the milestone you both signed. "Our agreement says this stage is done when [event]. Here's the checklist with each item and the date it was completed. If one of those agreed conditions hasn't happened, the stage isn't done, and we'll finish it. If they have, we go by the trigger we signed rather than a new definition made now."

This case teaches more than a failed inspection, because it tests the whole system: the signed trigger, the checklist, the evidence and the payment timing. It also shows the limit. If the signed trigger was vague ("mostly complete"), no checklist can fix it after the fact. That's why the trigger is written as an event before the job starts.

4The math

The published bathroom, divided. The 5×8 bathroom has a direct cost of $11,799.17 and a contract of $17,698.76 at the published 1.50x illustration. The payment amounts are the invoice guide's worked schedule, and how they were sized is explained there.

The published 5×8 bathroom, divided into milestones
MilestoneTriggerWhat the checklist holdsPaymentStage direct cost
DepositThe agreement is signedAgreement signed; selections ordered$4,749.85Not a production stage
Demo and rough-inWhen demolition startsProtection set up; demolition started$5,490.00$5,160
Tile, flooring, paintWhen tile startsSubstrate ready and inspected where required; tile begun$4,375.43$3,384
Carpentry, vanity, fixtures and cleanupWhen carpentry startsTile complete; vanity and fixtures on site$2,729.50$3,255
FinalAt the final walkthrough, under the agreementFinal walkthrough held; closeout record prepared under the contract (see closeout)$353.98Not a production stage

Stage direct costs are rounded, from the invoice guide's worked example. The five payments add up to the contract: $4,749.85 + $5,490.00 + $4,375.43 + $2,729.50 + $353.98 = $17,698.76.

What a vague trigger costs. Suppose payment 2 had been written "due when rough-in is mostly done" instead of "when demolition starts", and the argument over "mostly" delays it by 14 days (an illustration).

Payment delayed = $5,490.00
Days delayed = actual payment date − the date the agreed event happened

You wait 14 extra days for that cash while you keep paying whatever job costs come due in the meantime. The stage's published direct cost is $5,160, but how much of it becomes contractor-funded during those 14 days depends on when the costs are actually paid and what customer cash is already on hand:

Cash exposure = job cash paid to date − customer cash received to date

When that number is positive, the customer's job is running on your money, which is what the invoice guide's start-of-stage rule exists to prevent.

5The rule that protects you

Every payment milestone is an objectively identifiable event, never a percentage complete or a calendar date.

"When framing starts" holds up. "When framing is 50% complete" is an argument. "On October 12" turns a weather delay into a late payment, or a payment for work that hasn't happened. Write the event in the signed agreement, decide start or done before the job starts, and keep dated evidence when you reach it.

A clear milestone doesn't override your state's home improvement payment law. Have your contract and payment triggers reviewed in your state.

6The policy decisions

Decide these before the contract is signed.

Milestone policy
DecisionOptionsThis guide's practice
Where to divide the jobBy dollar size; by length; at control pointsAt control points: where payment, an inspection, a handoff to another trade or the next major phase changes. No count by job size.
Start or doneStart for every stage; done for every stage; by stageBy stage, decided before signing. Start where cash funds the stage (the invoice guide), done where completion is the point.
InspectionsTheir own milestone; a condition inside one; separateA condition inside a "done" milestone when passing it gates the next phase. Otherwise keep it separate from payments.
Customer sign-off per stageRequire it; offer it; rely on your recordNot by default. The signed agreement plus your dated report and evidence. Sign-off only where the contract, a lender or state law requires it.
EvidenceNothing; a checklist; a checklist with photosA dated checklist, with photos where they show something, including the signed inspection card.
What moves a milestoneThe calendar; the eventOnly the event. A slipped date moves the planned date. A changed event needs a signed change order.

Financed work. In HUD's FHA 203(k) rehabilitation program, the contractor completes a phase, the work is inspected, and the draw is released through the lender. For financed jobs, the milestone that releases money may be "inspected and accepted", not your start-of-stage trigger. Follow the lender's draw agreement.

State law. In California, a home improvement contract's progress-payment schedule must describe each phase and the work or materials it covers. Except for the down payment, the contractor may not ask for or accept more than the value of the work performed or the material delivered (Bus. & Prof. Code §§ 7159 and 7159.5). The down payment is generally limited to the lesser of $1,000 or 10% of the contract price. So a covered California contract can't use a start-of-stage payment to collect more than the value of work already performed or materials already delivered. Start timing isn't the issue; the amount collected is.

In Massachusetts, a home improvement contract must include a payment schedule. The deposit is generally capped at the greater of one third of the price or the cost of special-order materials, and the final payment can't be demanded until the work is completed to the parties' satisfaction (M.G.L. c. 142A § 2).

These are examples, not a survey.

Patterns by job type. These are shapes, not counts
Job typeTypical pattern
One-visit serviceAuthorization, then completion. Often one payment event.
Specialty replacementA deposit or material commitment, then installation start or completion, then the final payment.
RemodelSeveral visible production stages, then closeout.
Addition or new homeMore production and inspection gates. When it's financed, the lender's draw schedule controls when money is released.
7What happens next
The invoice bills the milestoneSee the invoice guide.
Job costing reviews cost by stageA stage that ran over shows you where the next estimate is off. See job costing.
The last milestone hands off to closeoutSee closeout.
The list becomes your templateThe milestones of a finished job are the starting point for the next similar one.
8Objections and the usual mistakes

What customers say about a milestone, and what to say back.

Objections
The customer saysWhat to say back
"It doesn't look done to me.""Let's use the trigger in our agreement. It says this stage is done when [event]. Here's the dated checklist. If an agreed condition is still open, we haven't reached it."
"The inspector hasn't been yet.""The question is whether passing inspection is part of this milestone's signed trigger. If it is, the milestone waits. If not, the inspection is a separate step."
"Why is it due before you've finished?""Our agreement makes this stage due when it starts, not when it's finished, so the stage is funded before the work. Your state's payment rules still control what we can collect."
"You're behind, so I'll pay late.""The planned date and the payment trigger are different things. If the stage hasn't started, the payment isn't due yet. Once the signed event happens, the agreement's payment terms apply."
The usual mistakes
MistakeWhat to do instead
"50% complete" as a triggerName an event anyone can identify.
A calendar date as the trigger for a production stageUse the event in the agreement, and keep the planned date movable.
Defining "done" when you send the invoiceDefine it before signing.
Letting the checklist redefine the contractThe checklist documents the trigger. The signed agreement defines it.
Too few stages on a long jobDivide where payment, inspection or the next major phase changes.
Too many tiny stagesCombine work that has nothing depending on it.
Billing because the calendar says the stage should have startedBill on the event.
Assuming every payment waits on inspectionSay in the agreement whether passing inspection is a condition.
Saying your software verified the workSay what you reported, with your evidence.
Moving a milestone without updating the scheduleMove the planned start and the schedule together.
Using start-of-stage billing everywhereCheck your state's law first. California limits payments to work performed.

What it means

What this saysDivide the job where the work visibly changes, write each payment trigger in the signed agreement as an event, decide before the job starts whether each stage is due when it starts or when it's done, keep dated evidence that you reached it, and when the date slips, move the planned date and leave the event alone.
Every payment milestone is an objectively identifiable event, never a percentage complete or a calendar date.

Milestones in Clamp

Each payment in the proposal's schedule is a milestone with a trigger: at signing, on a date, at a milestone event, or at completion. A stage payment is due when its stage starts or when it's done, and the customer sees the signed line, such as "Due when demolition starts". On the job, each milestone has a "What has to be done" checklist. Check items off as they're completed, and add photos to any line, such as the signed inspection card. Mark done makes the payment ready to invoice. On a job with a customer portal, the customer sees each line and its photos, labeled as your statements, not Clamp's findings. For a stage due when it starts, send a start notice. A Jobsites schedule item can name the stage it starts. Moving that item offers to move the stage's planned start too, and the payment never becomes late because the date moved. Home shows stages starting within three days whose notice hasn't gone out, with a reminder the morning before. Clamp doesn't get customer sign-off on a stage, track inspections or handle lender draws.

Before you write the next payment schedule, see how to set a payment schedule and invoice for sizing each payment, and the Clamp method for where milestones sit between the proposal and the invoice.
