model

How to Close Out a Remodeling Job: Punch List, Final Payment, Warranty, and Handoff

A job isn't finished because the last tool leaves. What closeout includes, sample wording from the final walkthrough to the referral ask, the final balance on a published bathroom, lien waivers in plain terms, and the rule that complete is defined in the contract.

Direct answer: A job isn't finished because the last tool leaves. Closeout is finished when you have followed the contract's definition of complete, documented the punch list, reconciled the final invoice and resolved or documented its payment status, completed any required permit closeout, and handed the customer the records they need. Walk the job with the customer once and write one punch list you both sign. Make the final invoice reconcile: the contract, plus signed changes, less every payment made. Collect the lien waivers your state or contract requires, hand over the warranty terms and care records in writing, review the job's cost, and once the customer is happy, ask for a review and one referral.

The assumptions

This model assumes

  • A residential remodeler, solo or with a small crew and trade subs
  • The contract and payment schedule are the published 5x8 bathroom, version 3, as scheduled in the invoice guide
  • One year on workmanship is the owner's practice, not a standard
  • Sample language is a drafting example, not legal advice; lien and warranty law vary by state

The model, step by step

1Where it sits

Contract completion, the punch list, the final payment, permit closeout and the start of the warranty are related events. They aren't automatically the same event.

Closeout against what it gets confused with
Event or recordWhat it is for
The contract's definition of completeSays when the work is complete, how the punch list is handled, and when the final payment is due. Everything below follows from it.
The final walkthroughOne deliberate visit to compare the finished work with the contract and signed changes.
The punch listThe remaining contract items, written down and agreed. It separates unfinished work from later warranty claims and new requests.
The final inspection or permit closeoutWhat the building department requires, when a permit was pulled. It runs on its own timeline.
The final invoiceThe last bill, reconciled to the contract, the signed changes and the payments already made.
Lien waivers or releasesA record that specified lien or payment rights are released, conditionally or unconditionally, using the form and timing your state requires.
The handoffThe warranty terms, care and maintenance, manuals, selections and paint colors, given to the customer.
The warranty periodWhat you'll come back to fix after completion, for how long, under the written terms.
Closing out a tradeEach sub finishing their part on the jobsite. See how to coordinate a remodeling jobsite.
Closed in ClampYour internal record that you marked the job Closed. It isn't proof that the contract is complete, that you've been paid, that permits are closed, or that the warranty has started.
2What closeout includes

Sorted from always to only if listed.

What closeout includes
ItemWhenWhy
A final walkthrough with the customerAlwaysOne point where you both compare the work with the contract.
A written punch listAlwaysSeparates unfinished contract work from later warranty and new-work requests.
Customer sign-off on the listAlwaysRecords what both sides agreed remained, and when it was done.
A final invoice that reconcilesAlwaysThe final balance ties to the contract plus signed changes less payments. It is never a new, unexplained number.
Final payment statusAlwaysReconcile what is due, and record whether it was paid or remains disputed. Financial closeout isn't complete while an amount is unresolved.
A job cost reviewAlways, internallyCompares estimated and actual cost before the next similar estimate.
Warranty termsUsually, and already in the signed contractThe handoff reminds the customer what applies. It never invents new terms.
Care and maintenance informationUsuallyFinishes and products often have care requirements.
Product manuals and manufacturer warrantiesUsually, when products were installedThe customer needs them for the products, separate from your warranty.
Selections and paint colorsUsuallyFor touch-ups, repairs and the next job at the same house.
Final photosUsuallyA record of the finished work.
The review and referral askUsuallyOnce the customer is happy.
The final inspection or certificate of occupancyWhen the permit requires itDepends on the jurisdiction and the work.
Lien waivers or releasesWhen your state's law or your contract requires themThe right form and timing are set by state law.
A check-in before the warranty endsOnly if it's your policyA service habit, not a requirement.
Maintenance visitsOnly if sold or promisedDon't create an obligation the contract never included.
3How to close it out, step by step

The lines below are this guide's examples to adapt, not a script or legal advice. Have your contract's completion, punch list, payment and warranty terms reviewed in your state.

Inviting the final walkthrough"The work is ready for our final walkthrough. We'll go through it together, write down anything still left under our contract, and leave with one punch list we both agree on."
Writing a punch item"Touch up paint at the lower left corner of the hallway door casing."

Not "fix trim" or "paint issue". Each item names the place and the fix, so both of you can tell when it's done.

Signing off the list"These are the remaining items we agree are open under our contract and signed changes. Anything reported later we'll sort as unfinished contract work, a warranty issue, damage or maintenance, or new work."

Michael C. Stone, a builder and remodeler with more than six decades in the industry and the author of Markup & Profit: A Contractor's Guide, Revisited, puts the punch list in the contract: one list, put together jointly, tied to the original contract and signed change orders, signed off as items are done. After completion, later issues move to the warranty.

The final invoice"The final contract amount is the original contract plus the signed change orders. After every payment you've made, the balance is $353.98."

The final invoice is never where undocumented extras appear for the first time. Under this guide's change-order rule, unsigned extra work doesn't first show up on the final invoice.

The handoff"Here are your warranty terms, the care information, the product manuals, and the paint colors and finishes we used. Keep these with your house records."
The warranty"Your written warranty says what's covered, what isn't, when it starts and how to report a problem. If something comes up, send us where it is, what you're seeing and a photo if it helps."

Don't promise a different term at closeout than the signed contract gives.

The review"If you're happy with how it turned out, would you be willing to leave us a review?"
The referral"And if one person comes to mind who'd be a good fit for the kind of work we do, I'd appreciate an introduction."

In Profitable Sales: A Contractor's Guide, Stone has the salesperson visit shortly after completion to see how the job turned out, confirm the customer is satisfied, learn what could have gone better, and ask for a referral. He suggests asking about one person rather than "who do you know?".

The check-in before the warranty ends"Your warranty runs through [date]. If there's anything you think it covers, send it to us before then so we can look at it."

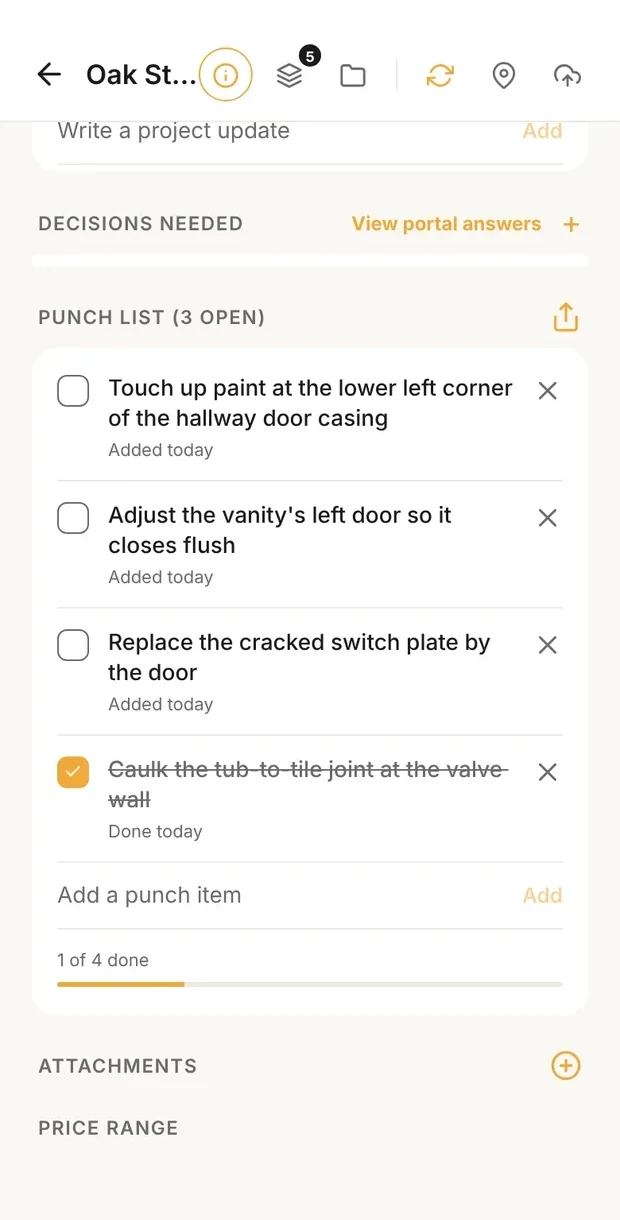

Clamp's punch list for the Oak Street Bathroom, 3 open: touch up paint at the lower left corner of the hallway door casing; adjust the vanity's left door so it closes flush; replace the cracked switch plate by the door; caulk the tub-to-tile joint at the valve wall, done today; 1 of 4 done

The punch list

Clamp's Share punch list for the Oak Street Bathroom, Open only selected: the three open items checked, the completed caulking item listed under Completed, 3 of 4 selected, with Cancel and Next

Sharing it for sign-off

The Oak Street job's punch list in Clamp, and sharing it: open items only or everything, as a text or as a PDF with Contractor and Homeowner sign-off lines. Demo data on the published 5x8 bathroom.

The hard case: the customer holds the final payment over one item"I'm not paying the final invoice until that cabinet door is adjusted."

Answer with the contract and the signed punch list, not a feeling. "The cabinet door is on the punch list, and we'll adjust it. When the final payment is due is set by the completion and payment terms we signed. If those terms allow an amount to be held for an open item, we'll write down that amount for that item. Otherwise we follow the payment terms as written."

This case teaches more than a customer who keeps adding items, because it separates completion, punch work, money and the contract. Don't tell the customer they're legally required to pay with an item open. That depends on the contract and your state's law. A small final payment limits how much is still outstanding at closeout. That's why the payment schedule is designed before construction starts: see the invoice guide.

4The math

The final balance on the published 5x8 bathroom, using the payment schedule from the invoice guide.

The final balance
Line5x8 bathroom
Original signed contract$17,698.76
Plus signed change ordersNone
Less signed creditsNone
Adjusted contract total$17,698.76
Less payments received (deposit $4,749.85 and three stage payments: $5,490.00, $4,375.43, $2,729.50)$17,344.78
Final balance due$353.98
Final balance = original contract + signed additions - signed credits - payments received

Cross-check: the payments received plus the final balance equal the adjusted contract total. It should also equal the final payment in the signed schedule, plus any change billed to the final payment. Here the schedule's final payment is $353.98, so it ties. If it doesn't, find out why before you send it.

The job cost review. Compare estimated with actual cost, by category, before you close the books on the job:

Variance = actual job cost - estimated job cost

In Estimating Construction Profitably, chapter 12, Stone has you job-cost every completed job, comparing actual against estimated labor, materials, subcontracts and other costs, ideally section by section. With a mature estimating system, Emmanuel Forge's Minimum Pricing course aims to bring actual job cost within about 2% of the estimate, either way. That is his experience-based target, earned by repeating a scope, not a benchmark. The method, with a worked example, is in How to Job Cost a Remodeling Job.

5The rule that protects you

Complete is defined in the contract.

Write down, before the job starts:

What complete meansThe point the work is complete under the contract.
The punch listHow it is made and signed off.
The final paymentWhen it is due.
The warrantyWhat moves to it after that.

Then the walkthrough, the punch list, "while you're here", the final payment and the first callback all have an answer you agreed to in advance. Without it, the last week of the job is a negotiation.

This is the owner's practice. It doesn't replace your state's law: have the completion, payment and warranty terms reviewed in your state.

6The policy decisions

Decide these before the contract is signed.

Closeout policy
DecisionOptionsThis guide's practice
What counts as completeEvery punch item done; the contract's definition, with a defined punch listThe contract's definition. A defined punch list is part of a complete job, not a reason the job isn't complete.
Money held for punch itemsHold the value of open items; no new holdbackNo new holdback. The final payment is already small. If the contract allows withholding for an open item, write down a specific amount for that item.
The warranty termA term you set and have reviewed; no written termOne year on workmanship, as the owner's practice. Write what it covers, what it excludes, when it starts and how to report a claim, and have it reviewed for your state.
Before the warranty endsA second walkthrough; a check-in; nothingAn optional check-in, not a second inspection.
When to ask for a review and a referralAt the walkthrough; after the final payment, once the customer is happyAfter closeout and the final payment, once you've confirmed they're happy. Ask for one person, not "anyone".
Something reported after sign-offTreat it all as punch work; sort itSort it: unfinished contract work, a warranty claim, damage or upkeep, or new work. New work starts at the first call.

The FTC notes that builders' warranties, which can come with a new home or a remodel, vary in what they cover and for how long. One year is this guide's practice, not a standard. State law may also create implied warranty rights that differ from your written warranty, and may limit how those rights can be disclaimed.

7What happens next
The warranty period startsWhen your written terms say it does. Record that date. A callback under it is paid from the warranty program in your overhead, which is where the owner's course puts it. See overhead categories.
The job cost review feeds the next estimateIf labor ran over, the next similar job is estimated with the real hours. See How to Job Cost a Remodeling Job.
A happy customer is your next leadA referral or a repeat project comes in as a new lead and starts again at the first call.
8Objections and the usual mistakes

What customers say at closeout, and what to say back.

Objections
The customer saysWhat to say back
"I'm not paying until every last thing is done.""Let's use the completion and payment terms in our contract and the punch list we signed. Every remaining contract item is on it, and we'll follow those terms."
"I found three more things after we signed the list.""Let's sort them. A warranty issue we'll look at under the warranty. New work we'll price separately. If one is truly unfinished contract work, we'll add it."
"We'll pay after the inspector comes.""Let's check the contract. The final inspection and the final payment are separate unless our agreement ties them together."
"While you're here, can you just fix this too?""Happy to look. First let's decide whether it's punch, warranty or new work, so we record it right."
"Why do you need a lien waiver?""It documents which payment-related lien rights are being released, and whether that release is conditional on payment. The form depends on state law, so we use the one required here."
The usual mistakes
MistakeWhat to do instead
No definition of complete in the contractDefine complete, the punch list, the final payment trigger and the move to warranty before the job starts.
A punch list that never endsOne walkthrough, one signed list. Sort anything reported later as unfinished contract work, warranty, damage or maintenance, or new work.
Vague punch itemsName the place and the fix.
A final invoice that doesn't reconcileShow the contract, plus signed changes, less credits, less payments.
Extras appearing for the first time on the final invoiceIf it wasn't signed, it isn't billed there. Use a change order before the work.
A generic lien release from the internetUse your state's form where it provides or requires one.
Asking a sub for an unconditional waiver before they're paidAn unconditional waiver says payment was received. Match the waiver to the payment.
Treating Closed in your software as completionYour app's status is your record. Completion, payment, permit closeout and the warranty start are their own events.
No recorded warranty startRecord the date the written terms start it from.
Warranty terms given out loud at the handoffPut them in the signed contract and hand the customer a copy.
Skipping the job cost reviewReview every job before you price the next similar one.
Asking for a referral before checking they're happyConfirm they're satisfied, then ask.
"Know anyone who needs work?"Ask about one person who'd be a good fit.
Lien waivers, in plain terms. A conditional waiver takes effect only when its stated payment condition is met. An unconditional waiver states the payment has already been received, and releases the stated rights without that condition. A progress waiver releases rights only to the extent the form states, often through a date or payment and subject to listed exclusions. A final waiver is used with the final payment; it releases the claimant's stated payment and lien rights on the project, subject to any disputed claims it lists or exceptions in the statute. Some states provide or require statutory waiver forms. California, Arizona, Texas and Nevada are examples, not a complete list. Use your state's form and timing, and ask your attorney, title company or lender what applies.

What it means

What this saysDefine complete in the contract, walk the job once, sign one punch list, reconcile the final invoice to the contract, signed changes and payments, collect the lien releases your state requires, hand over the warranty and care records in writing, review the job's cost, and ask a happy customer for a review and one referral.
Complete is defined in the contract.
